Great Gadgets for Jira & Confluence

Release Burndown Burnup Chart Gadget

Overview

This gadget displays the burnup and/or burndown chart for a project release represented by a Jira filter. The calculation can be done by Story Points, Original Time Estimate, Work Item Count or by any numerical custom field, relying on historical data for each item within the specified filter. Additionally, you have the option to include sub-tasks in the calculation. The series to be displayed are configurable, thus allowing you to use the gadget as burndown, burnup or both, providing a flexible tool to monitor the agile progress of your project release.

Use this gadget to track the progress of your project release in an agile manner.

This gadget can also make a forecast (prediction) about when the release will be finished. How is the forecast made? First, the gadget determines the current velocity of your team based on the work done in the previous completed time intervals (Yesterday’s Weather). Then, it determines how many days are necessary to finish the current remaining work, assuming that your velocity remains the same, and it draws the dashed line accordingly to the determined release end date.

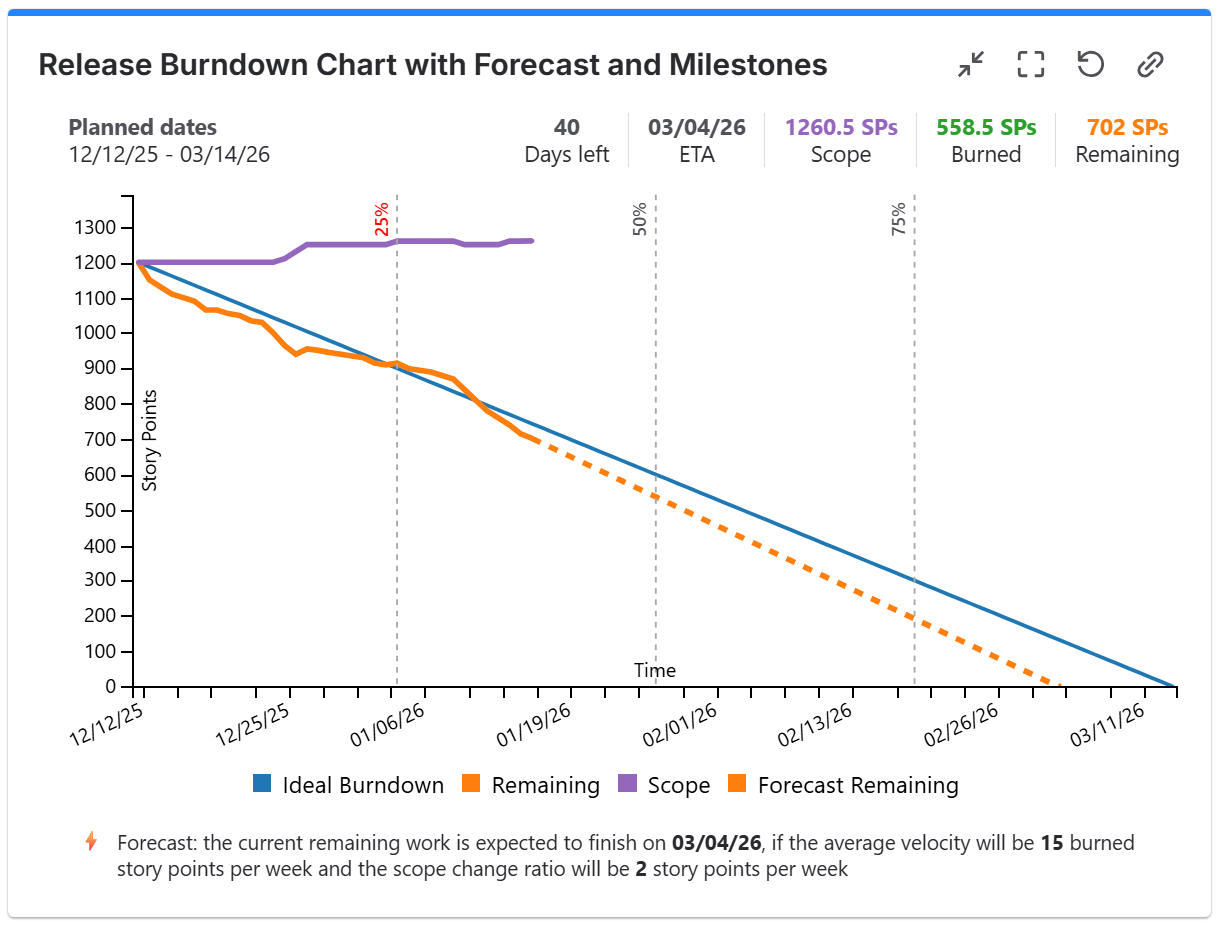

Optionally, you can choose to display the release milestones, such as at 25%, 50%, or 75% of the release timeframe. A past milestone will be displayed in red if the Remaining work at that time was higher than Ideal Burndown, or in green if it was lower, thus indicating if the milestone was reached or not.

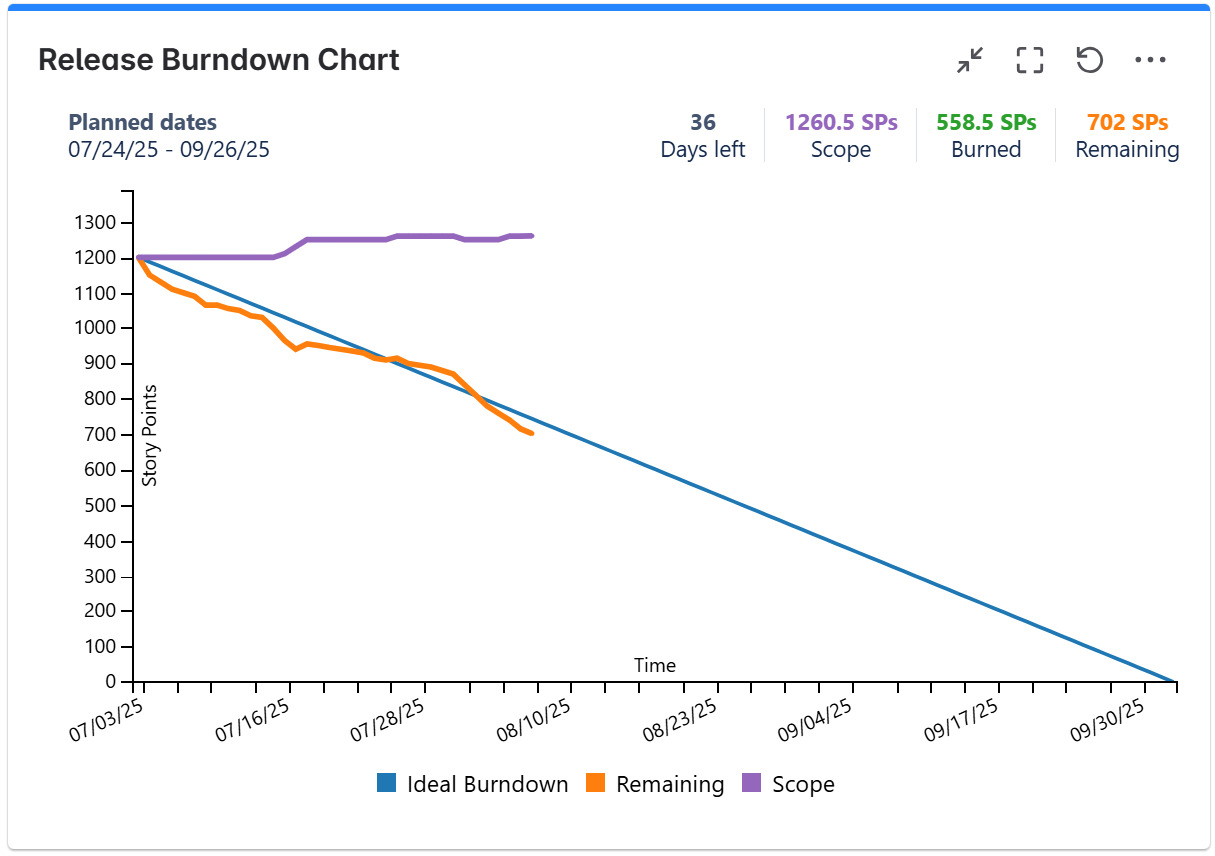

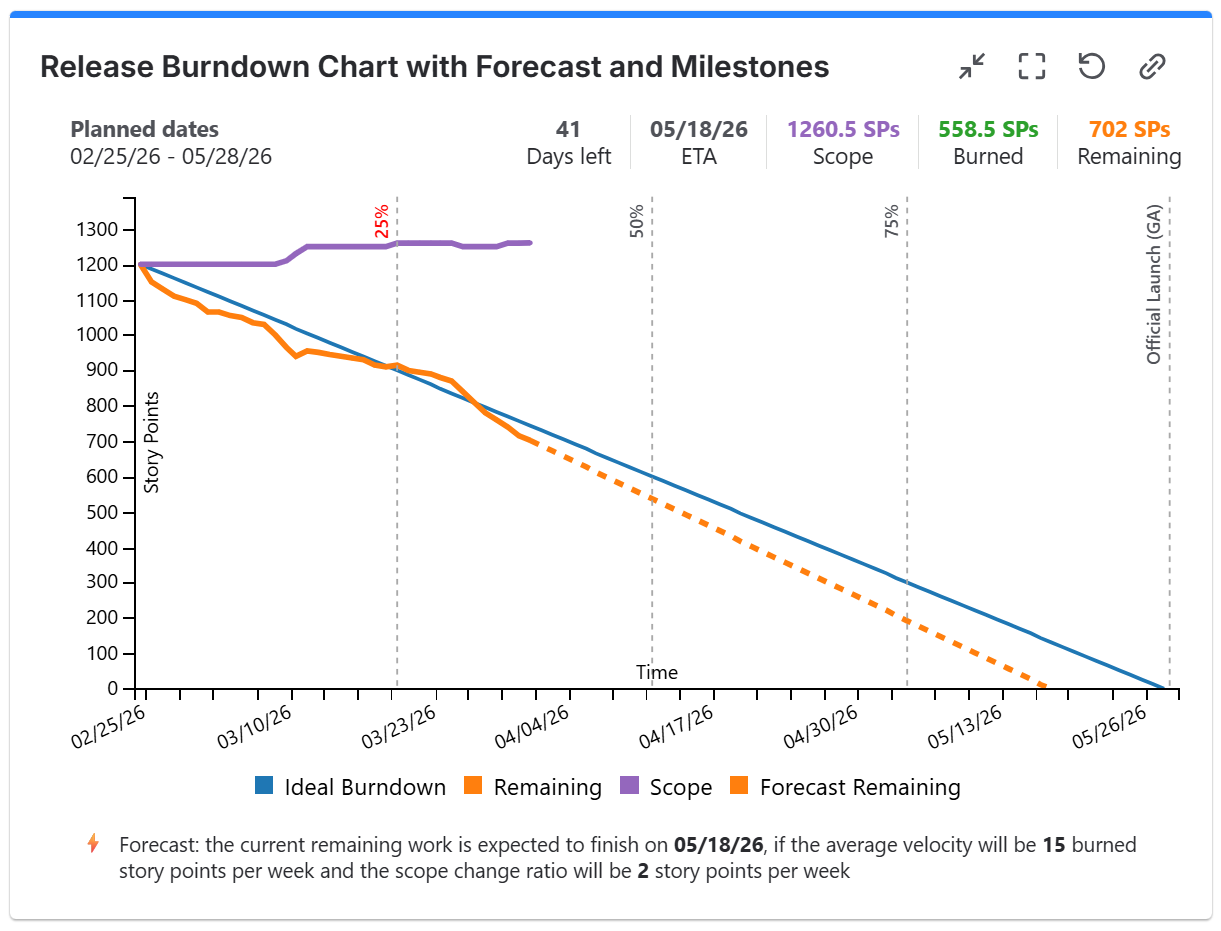

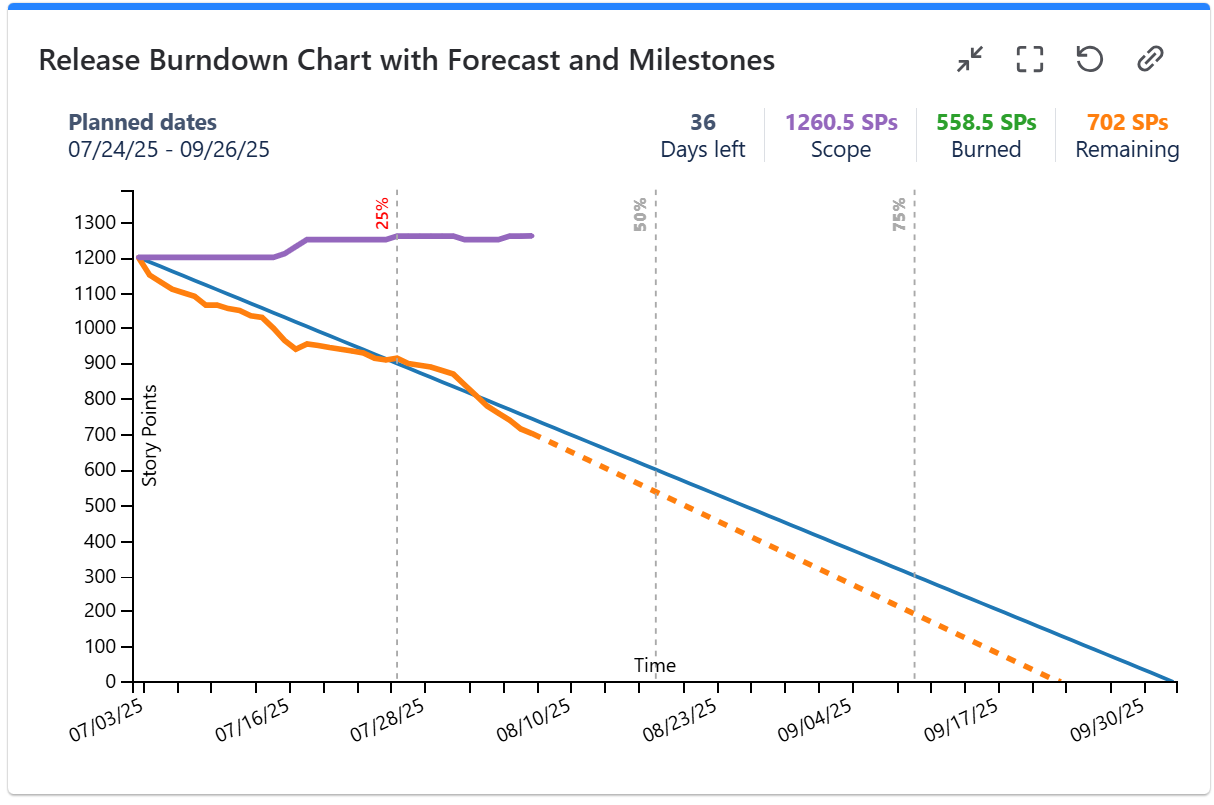

Release burndown chart with forecast and milestones.png

Configuration

The settings of this gadget are divided in multiple tabs:

  • Data tab - contains the required settings of the gadget, such as title or data source

  • Series tab - lets you choose what series (lines) to display in the chart

  • Forecast tab - contains settings for calculating the forecast lines

  • Milestones tab - lets you choose how to display milestones in the chart

  • More Settings tab - contains the optional settings

  • Colors tab - lets you customize the color of the lines displayed in the chart

Data tab

On this tab you can configure the required settings of the gadget.

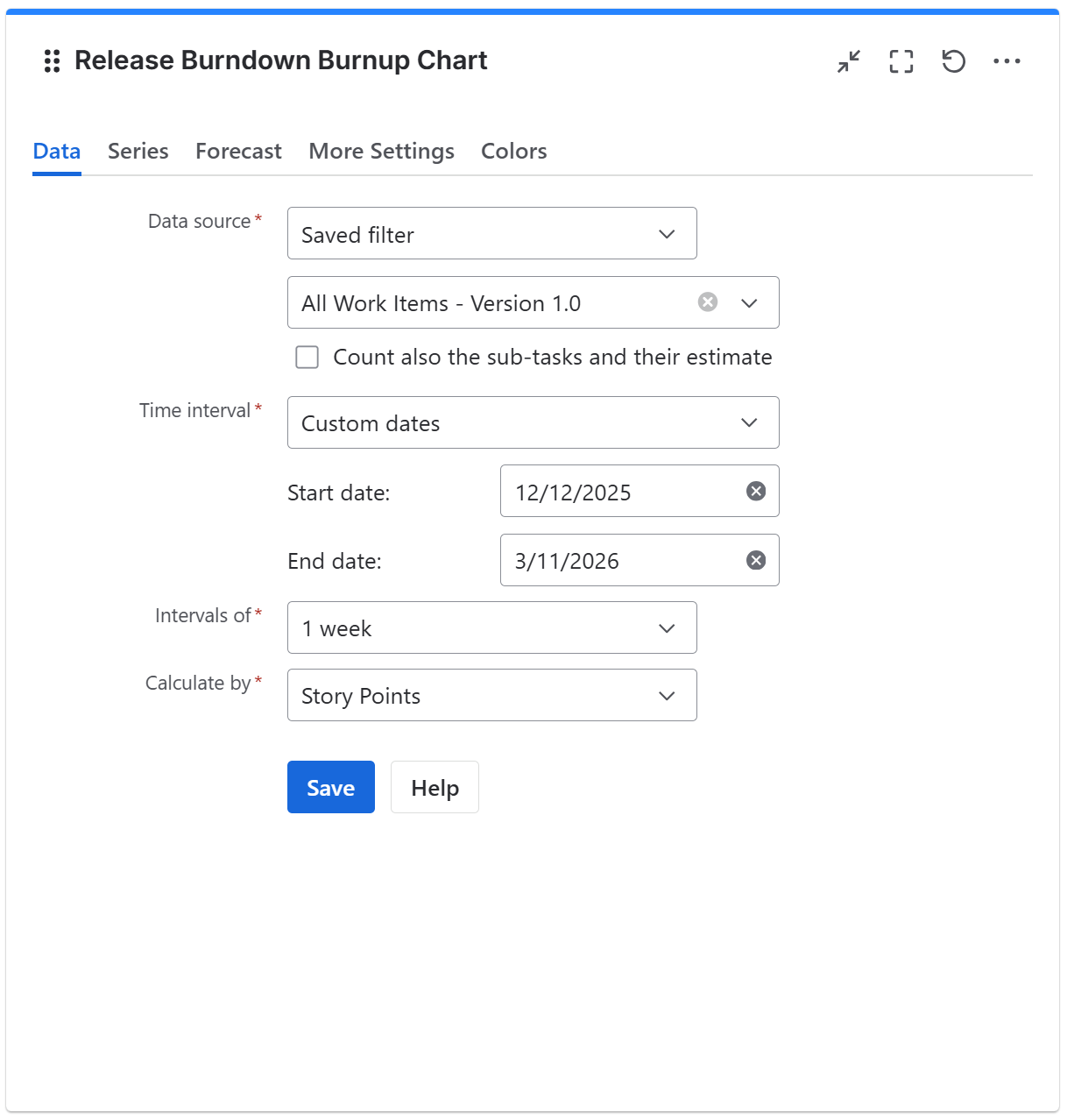

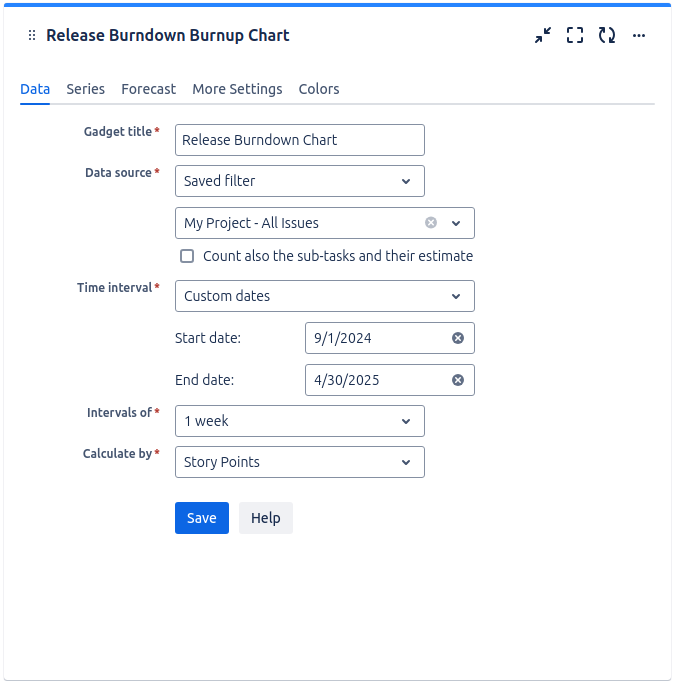

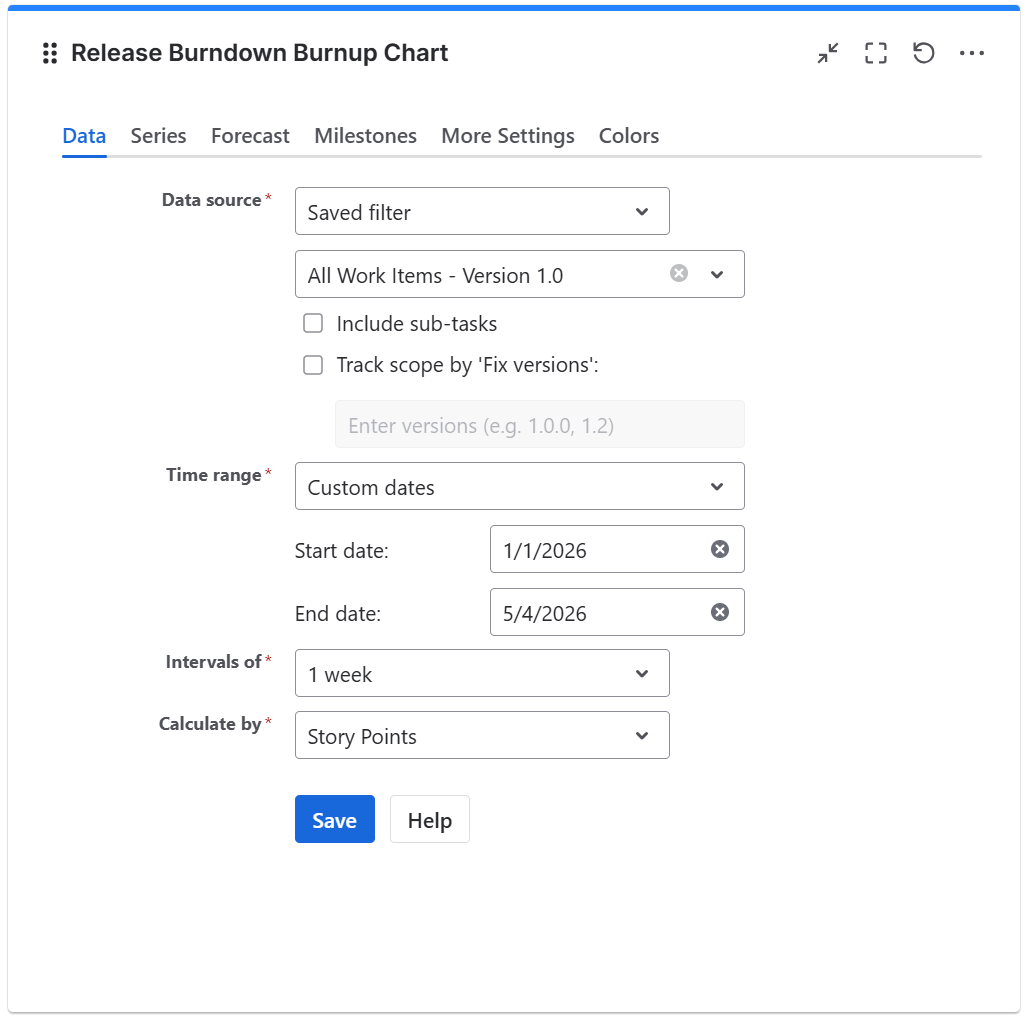

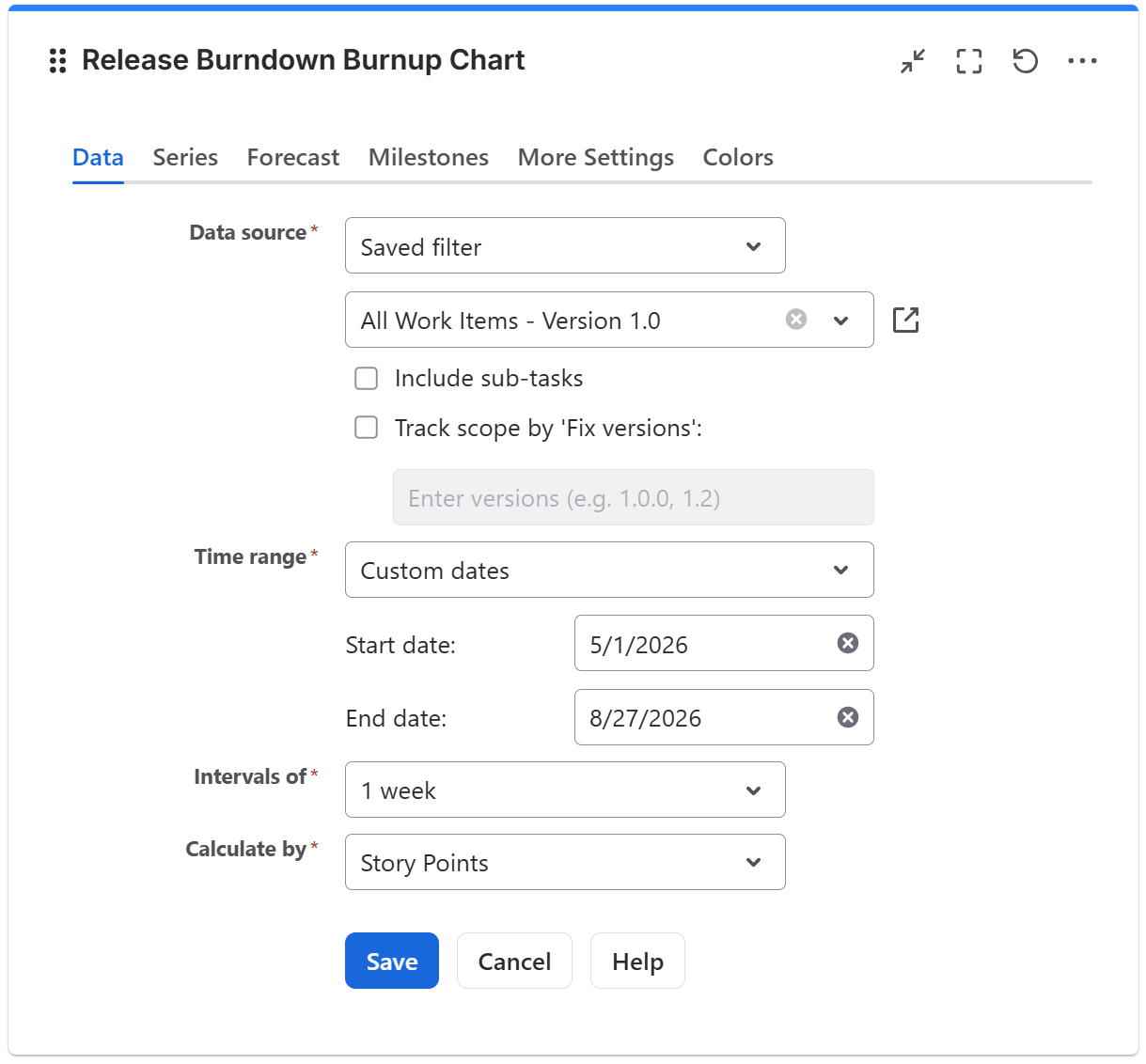

Release burndown burnup configuration - data tab.png

Setting

Description

Data source

Select the type of Data source used by the gadget:

  • A Saved filter that contains the Jira items in your release (the scope of your project release). Make sure that the specified filter is shared if you want other people to visualize the dashboard.

  • A JQL query that returns the items you want to be processed by the gadget.

  • Epics - Select one or more epics as the data source.

  • Portfolio-level items - Select one or more work items above the Epic level, such as Initiatives or Themes.

When a board or filter is selected as the data source, click the Icon.png icon next to its name if you want to view the selected board or filter in Jira.

Include sub-tasks

Select this option if you want the calculation to include the sub-tasks along with their estimate.

Track scope by 'Fix versions'

Select this option if you want to create version-based charts and track the release scope based on one or more values of the ‘Fix versions’ field. Make sure to enter the versions exactly as they are named in your projects.

When enabled, the gadget will exclude all other issues from the selected data source and will consider as being in scope only the issues whose ‘Fix versions’ field matches one of the specified values.

Time range

Represents the time interval of the release.

You choose from multiple options:

Custom dates - choose this option if you want to manually enter the Start date and End date of the release.

Dates of a project release - Choose this option if you want the gadget to use the start and end dates of an existing project release (added on the Releases page of a Jira project). Make sure the selected release has a Start date and End date set. Any subsequent changes to the release dates made on the project's Releases page will be automatically reflected in the gadget, without the need to reconfigure it.

Dates of a sprint - Choose this option if you want the gadget to use the start and end dates of an existing sprint. Only the dates are considered (not also the hours). The start of the interval will be the start date of the sprint with time at the start of day, while the end of the interval will be the end date of the sprint with the time at the end of day. When enabled, you’ll need to select the board the sprint belongs to. If you choose the Latest sprint (auto), the date range will automatically match the most recent sprint. If you choose the Previous sprint (auto), the date range will automatically match the sprint immediately before the latest one. If you manually select a specific sprint, any changes made to its dates on the board will be automatically reflected in the gadget, without the need to reconfigure it.

Be aware that you can also check the Continue to display data after release end date option in the More Settings tab if you want the chart to still display data even if the end date has passed.

Intervals of

Indicates the time interval for calculating the chart data. If you do Agile development, this should be set according to the length of your sprints or iterations.

Calculate by

Specify on which criteria the calculation to be performed. You can choose between:

  • Story Points - the default value; use this option if the work items are estimated in Story Points. If the work items are from team-managed spaces, select Story Point Estimate instead.

  • Original Time Estimate - use this if you use time estimates; calculation will be done in hours. The Scope will be calculated as the sum of the Original Estimate field of all the items from the filter, and each time an item is marked as done, the Burned and Remaining lines will increase/decrease with the amount of hours that is set at Original Estimate for that item. This option does not consider the time spent (work logged).

  • Time Remaining & Time Spent - use this option if you use time estimates and your team logs the worked time on a daily basis; calculation will be done in hours. The Scope will be calculated as the sum of the Time Spent and Time Remaining of all the items from the filter. Burned is calculated as the sum of Time Spent of all the items from the filter plus the sum of Time Remaining of all the items from the filter that are done. Remaining is calculated as Scope minus Burned. This option does not consider the Original Estimate field.

  • Work Item Count - use this if you want the calculation to be done by the number of work items.

  • Other numerical custom fields defined in your Jira instance - pickup the numerical custom field that you use to track or estimate the work items.

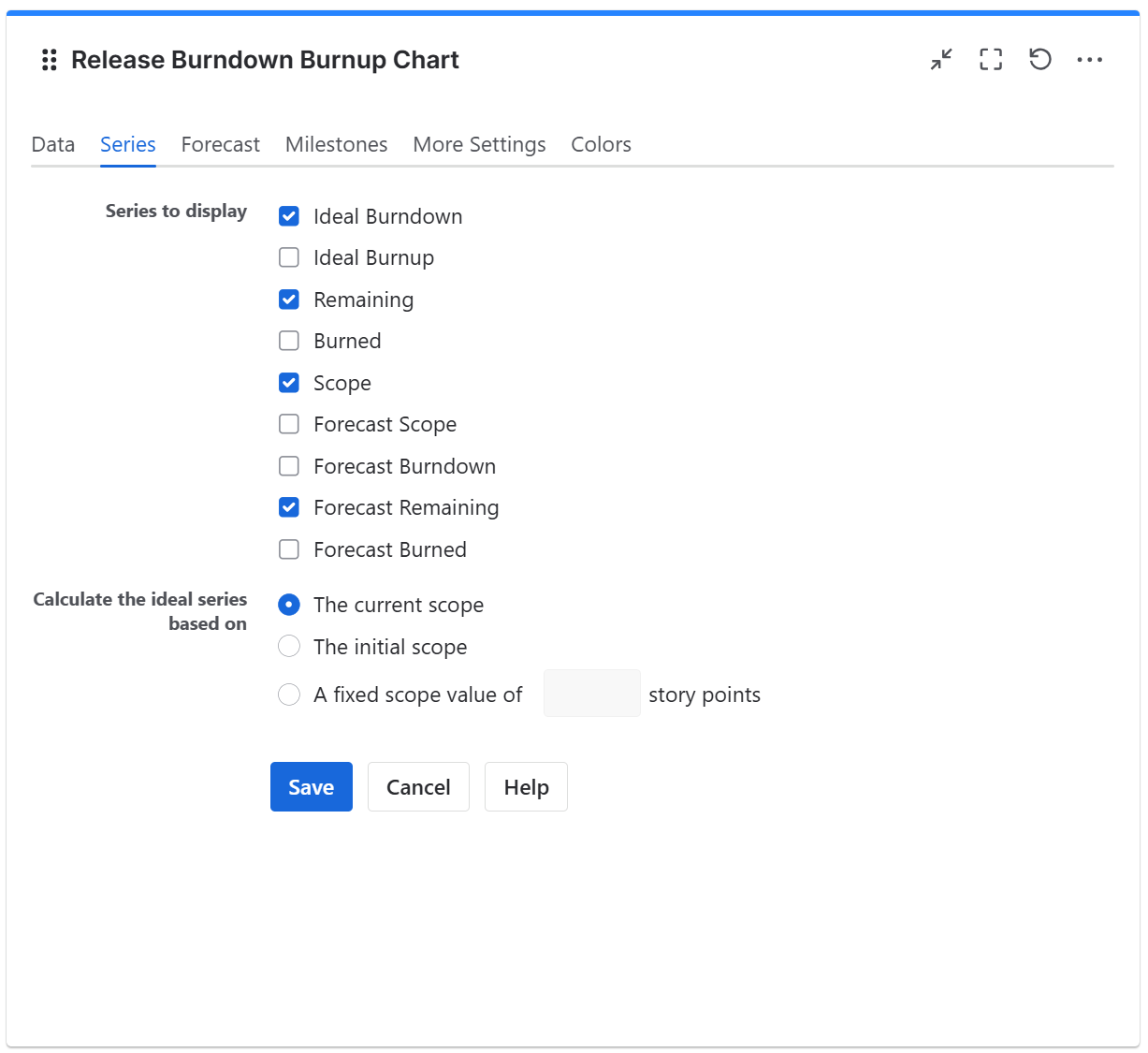

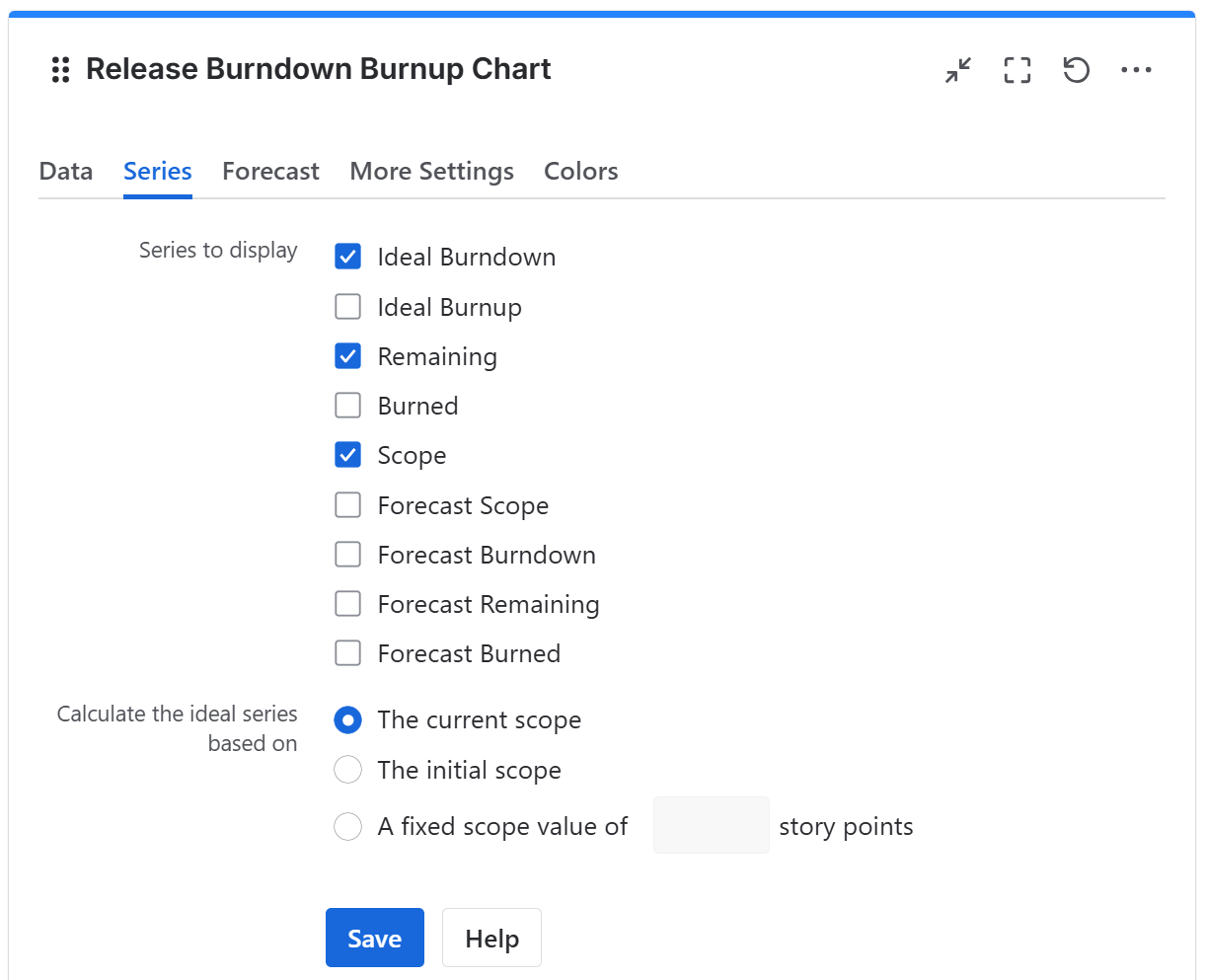

Series tab

On this tab you can choose what series to display in the chart.

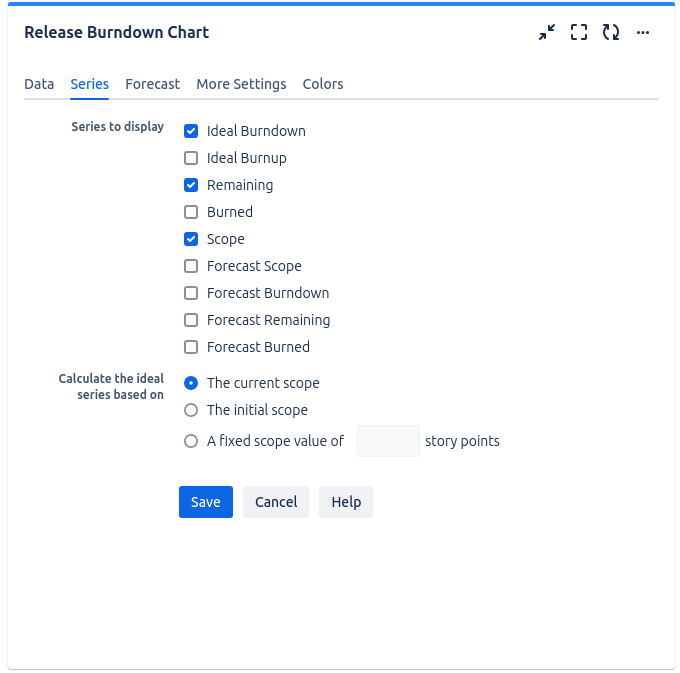

Release burndown burnup in Jira - series tab.png

Setting

Description

Series to Display

Choose what series to display in the chart. You can select one or more options:

Ideal Burndown - the ideal line specific to a burndown chart. It indicates how the remaining work should evolve in the ideal case. It is calculated based on Scope (see below).

Ideal Burnup - the ideal line specific to a burnup chart. It shows how the done (burned) work should evolve in the ideal case. It is calculated based on Scope (see below).

Remaining - the total amount of remaining work at that time; it is specific to the burndown chart.

Burned - the total amount of work done at that time; it is specific to the burnup chart.

Scope - represents the current release goal - the total amount of work to be done in the release at that time. Select this if you want to see the changes in the release scope over time.

Forecast Scope - makes a forecast (prediction) abou the scope and displays it as a dashed line between the end of the Scope line and the release end date.

Forecast Burndown - makes a forecast (prediction) about when the remaining work is finished and displays it as a dashed line between the start of the release and the estimated release end date.

Forecast Remaining - makes a forecast (prediction) about when the remaining work is finished and displays it as a dashed line between the end of the Remaining line and the estimated release end date.

Forecast Burned - makes a forecast (prediction) about when the remaining work is finished and displays it as a dashed line between the end of the Burned line and the estimated release end date.

The calculation of forecast lines is based on the settings in the Forecast tab.

Calculate the ideal series based on

Choose how the ideal series will be calculated. The current scope means that the Ideal Burndown line starts from a value that is the same as the current (latest) value of the Scope series, while The initial scope means that the Ideal Burndown line starts from a value that is the same as the value of the Scope series at the start of the release. You can also choose A fix scope value of and specify a number representing the total work estimate of the release. This third option is useful when you have a rough estimate of the total work but have not yet added all the corresponding work items or estimates in Jira.

Tips & Tricks

  • To configure the gadget as a "classic" burndown chart, select only the Ideal Burndown and Remaining series.

  • To configure the gadget as a "classic" burnup chart, select only the Ideal Burnup and Burned series.

  • To configure it as an epic burndown / burnup chart configure the gadget to use a filter or JQL that returns the work items from your epic(s): parentEpic in (EPIC-1, EPIC-2 …)

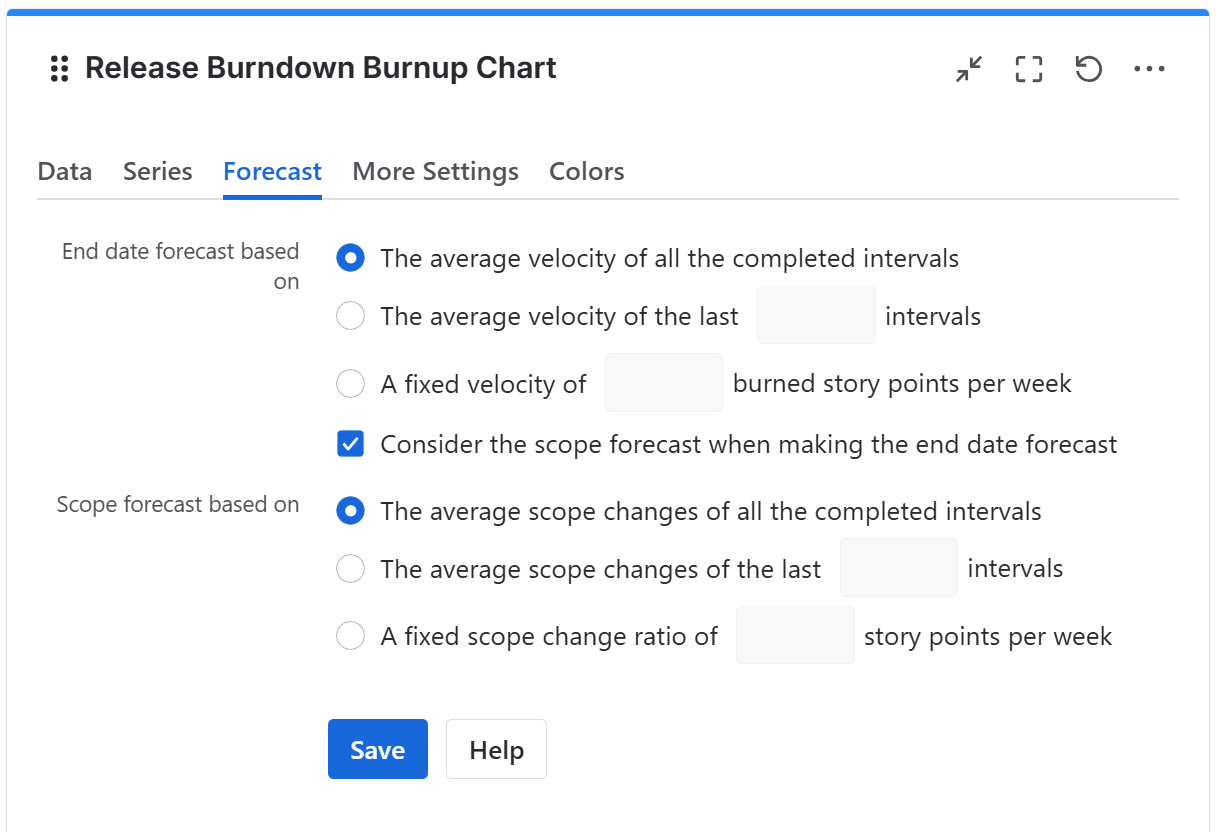

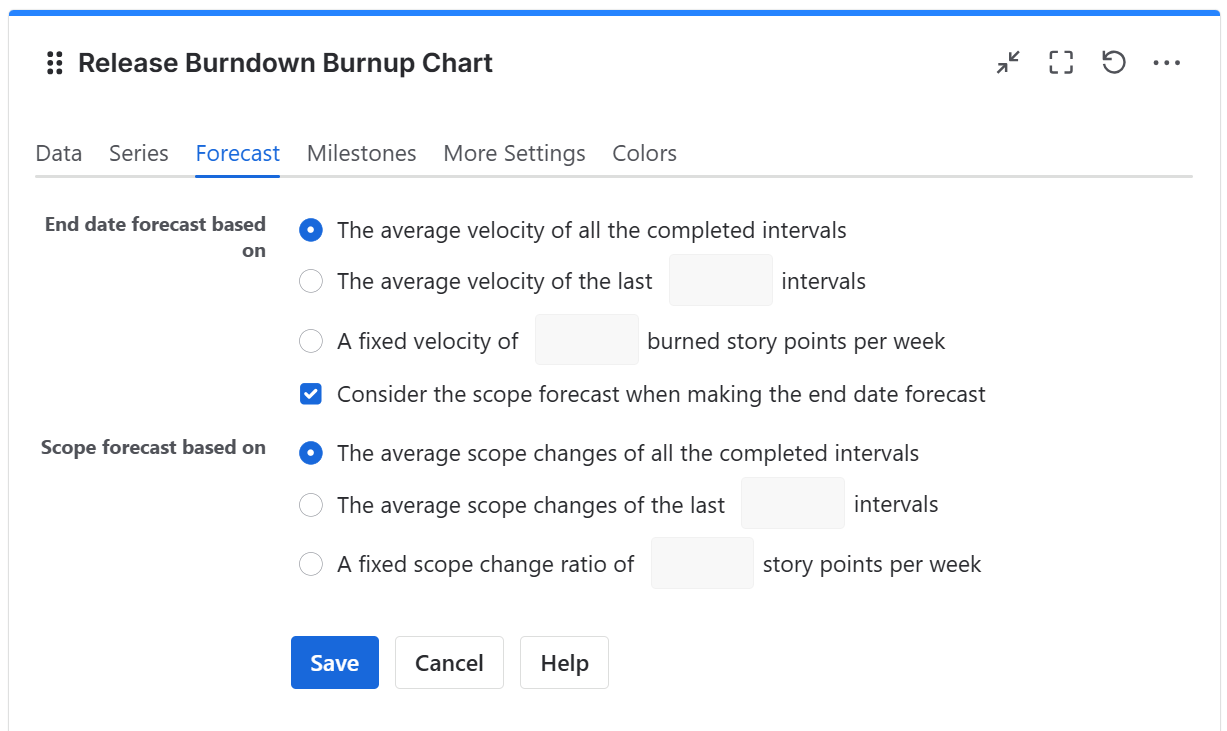

Forecast tab

On this tab you can define how the forecast lines are calculated.

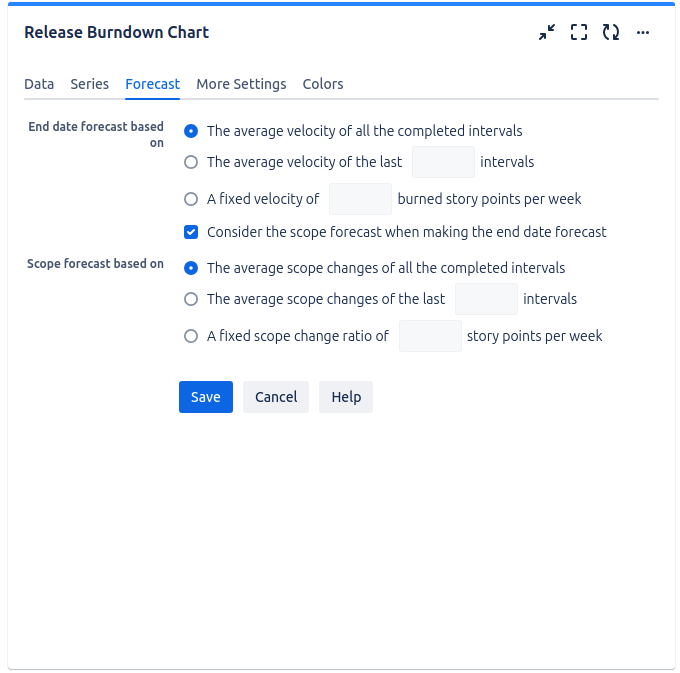

Release burndown burnup in Jira - foecast tab.png

Setting

Description

End date forecast based on

Specify how the end date forecast is calculated.

The average velocity of all the completed intervals - by choosing this option the end date forecast will be calculated based on the average velocity (average amount of work completed) of all the completed time intervals from the chart.

The average velocity of the last x intervals - by choosing this option the scope forecast will be calculated based on the average velocity (average amount of work completed) of the most recent x completed time intervals from the chart.

A fixed velocity of … - by choosing this option the scope forecast will be calculated based on a fixed velocity, entered manually.

These settings affect all the forecast series, except Forecast Scope.

Consider the scope forecast when making the end date forecast

By checking this option, the calculation of the end date forecast will also take into account the scope forecast, not just the velocity.

Scope forecast based on

Specify how the scope forecast is calculated.

The average scope changes of all the completed intervals - by choosing this option the scope forecast will be calculated based on the average scope change ratio of all the completed time intervals from the chart.

The average scope changes of the last x intervals - by choosing this option the scope forecast will be calculated based on the average scope change ratio of the most recent x completed time intervals from the chart.

A fixed scope change ratio of … - by choosing this option the scope forecast will be calculated based on a fixed change scope ratio, entered manually.

These settings affect the Forecast Scope series, as well as the other forecast series if the Consider the scope forecast when making the end date forecast is checked.

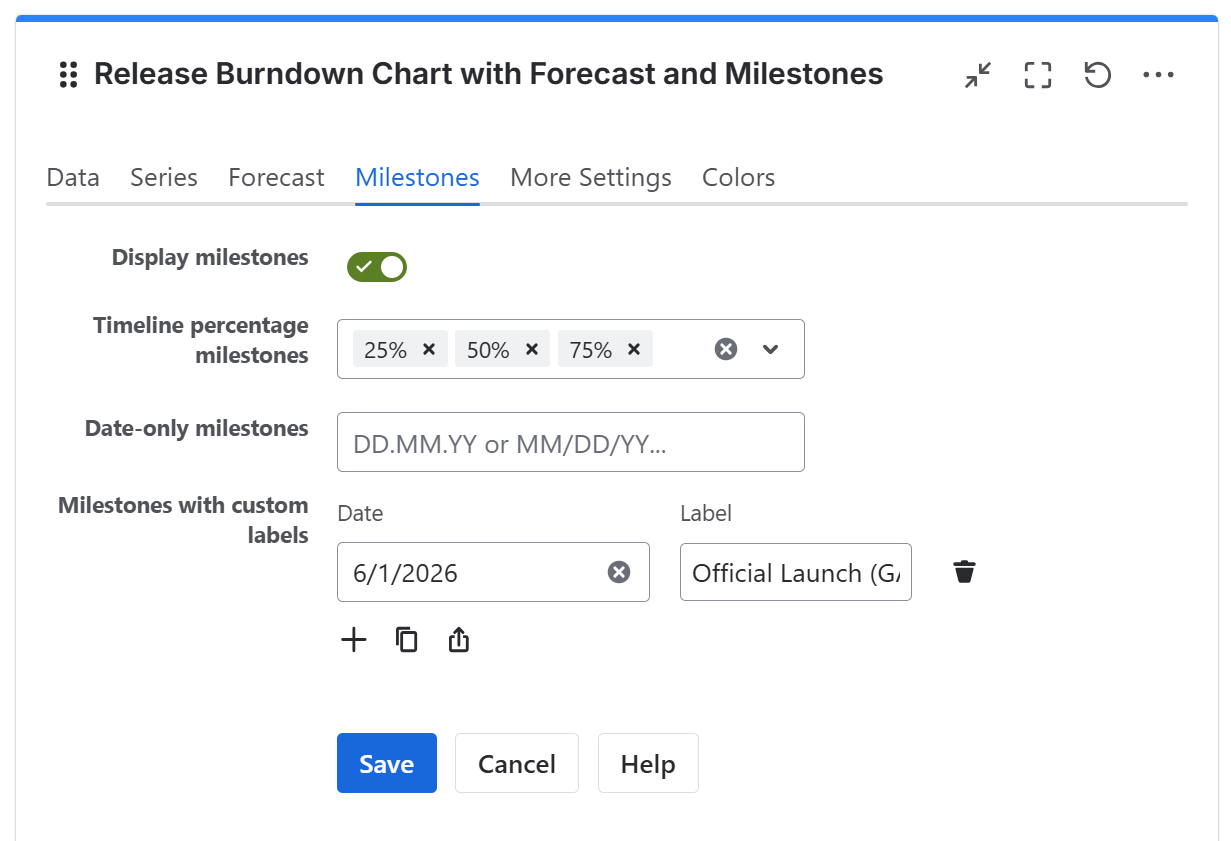

Milestones tab

On this tab you can configure how milestones are displayed in the gadget.

Release burndown burnup configuration - milestones tab.png

Setting

Description

Display milestones

Enable this option to display your configured milestones in the gadget.

Timeline percentage milestones

Enter the percentages values corresponding to the milestones to be displayed.

Date-only milestones

Enter the dates corresponding to the milestones to be displayed in either DD.MM.YY or MM/DD/YY format.

Milestones with custom labels

Select a milestone’s date and enter a custom label to be displayed in the gadget. You can add a new milestone by clicking the “+” button.

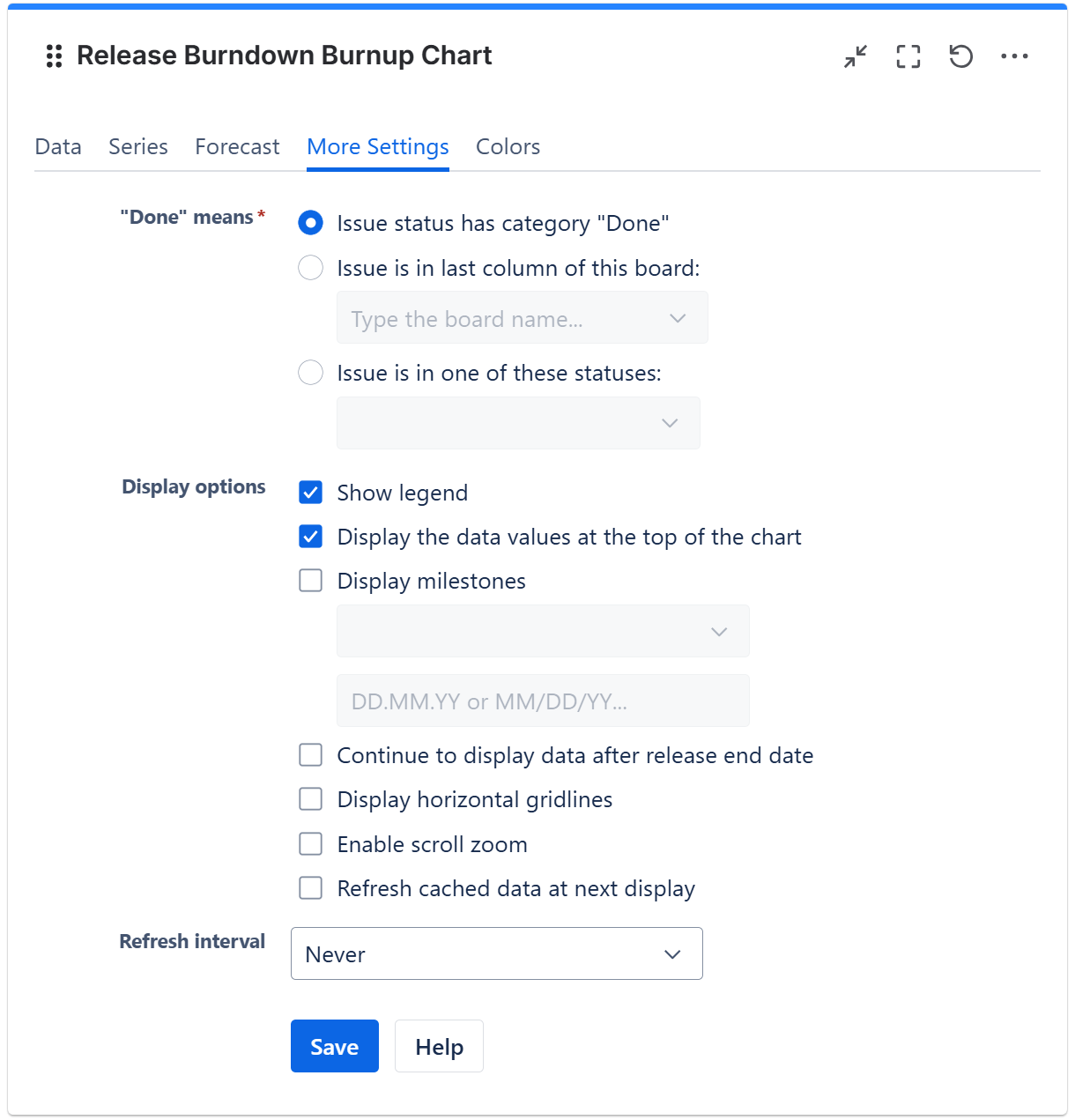

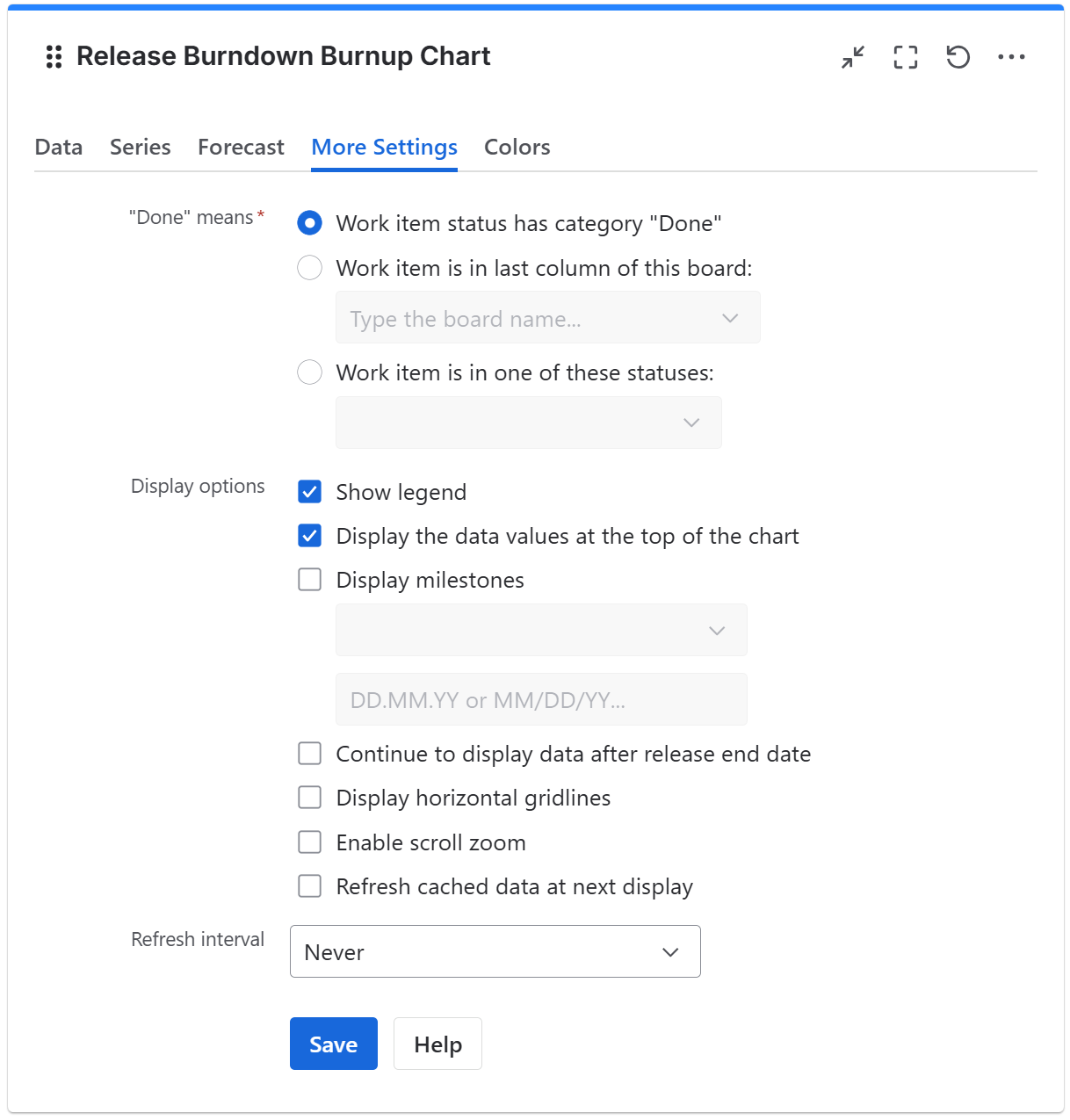

More Settings tab

On this tab you can configure the optional settings of the gadget.

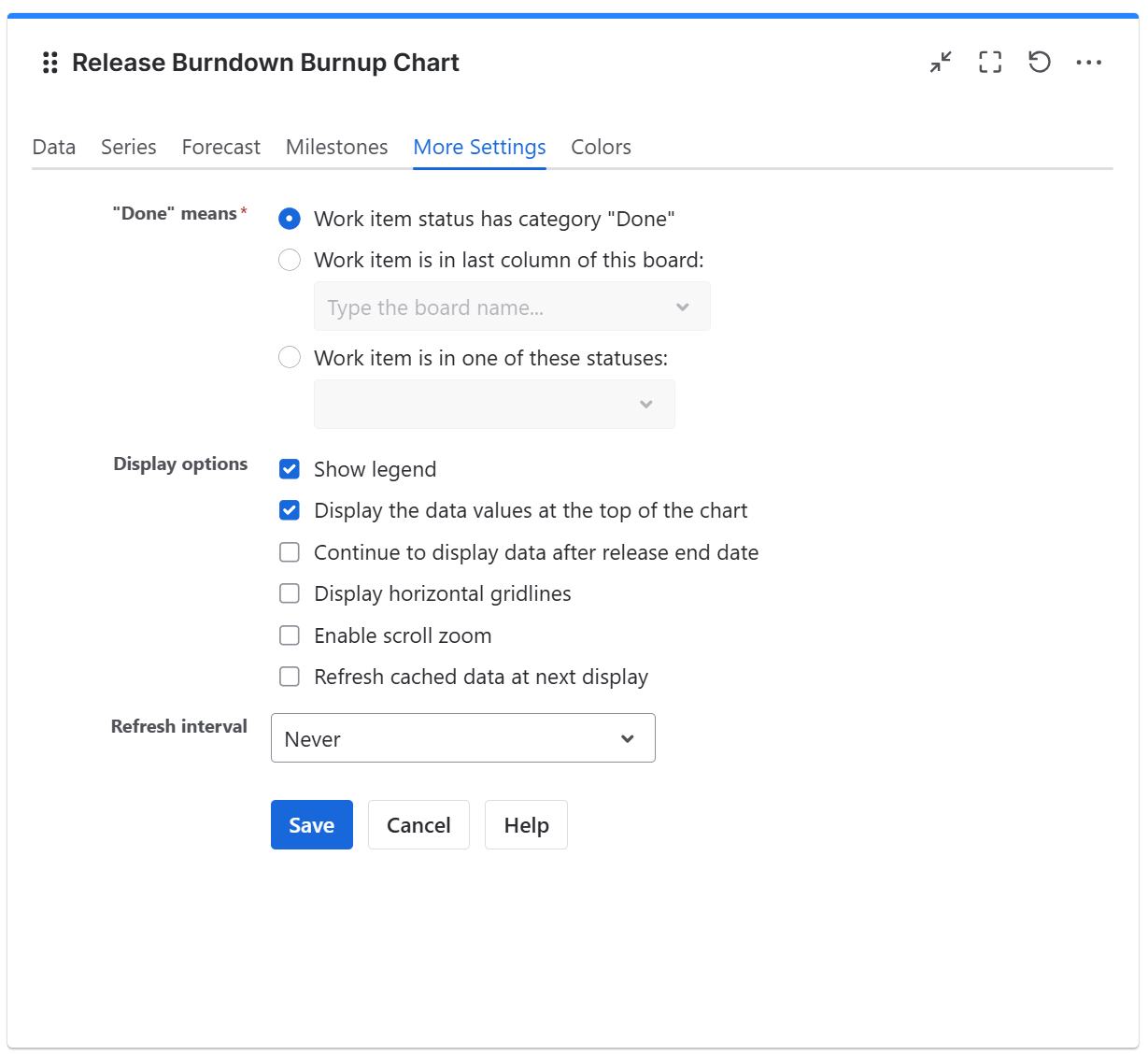

Release burndown burnup configuration in Jira - more settings tab.png

Setting

Description

"Done" means

Specify how the gadget should consider work items as done when determining the work completed.

The default option is Work item status has the category done, which means that the item is considered done if it has reached a “done” category status (such as Resolved, Closed, Done or any other green-colored status of Jira).

Choose Work item is in last column of the selected board and select an agile board if you want to consider items as done when they reach the last column of the board or, more exactly, a status that is mapped to the last board column.

Choose Work item is in one of these statuses, and then select one or more workflow statuses, to consider items as done when they reach one of these custom statuses.

Show legend

Check this if you want the chart legend to be displayed.

Display data values at the top of the chart

Check this option if you want the gadget to display key data values (like planned dates, ETA, days left, burned, remaining, scope) at the top of the chart. When possible, these values include a link that opens a filter containing the work items that produced that value.

Continue to display data after release end date

Check this option if you want the chart to still display data even if the release date has passed. When this option is checked, the chart lines Scope, Remaining, Burned and forecast will continue after the release end date.

Display horizontal gridlines

Check this option if you want the chart to display gridlines for the vertical axis.

Enable scroll zoom

Check this if you want to be able to zoom in while scrolling with the mouse wheel over the chart.

Refresh cached data at next display

This gadget uses data caching for faster display, which means that some resulting data after processing is saved and reused the next time the gadget is loaded. If you check it, the cache of the gadget will be cleared and recreated on the next reload. This setting is not persistent.

Colors tab

On this tab you can customize the color of the lines displayed in the chart.

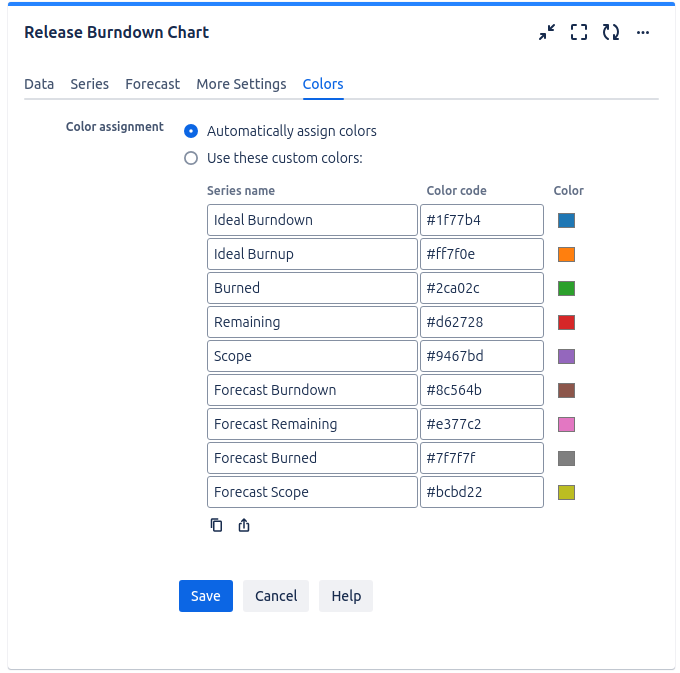

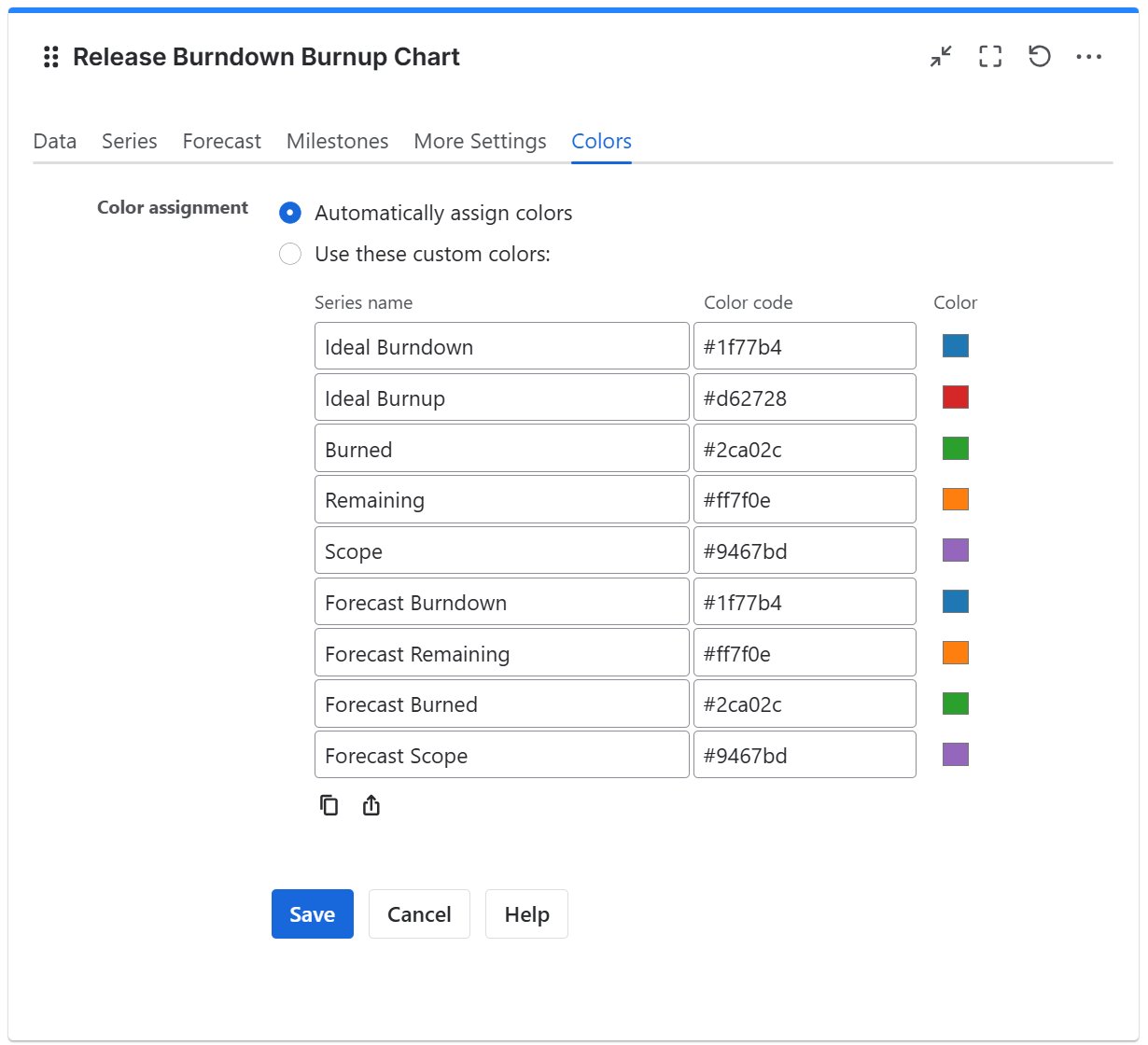

Release burndown burnup configuration in Jira - colors tab.png

Setting

Description

Automatically assign colors

Check this if you want the chart to automatically assign colors for the series.

Custom colors

Select any custom color you want the series to be displayed on by either entering the color's hexadecimal code or picking a color.

You can also use the Copy and Import buttons to copy and import the color configuration to gadgets of the same type.
