Great Gadgets for Azure DevOps

Release Burndown Burnup Chart

Overview

The Release Burndown Burnup Chart widget helps you track the progress of a project release in an agile manner. This widget displays the burnup and/or burndown chart for a project release based on a shared query. You can use this gadget as cross-project or cross-team burndown / burnup chart by configuring it with a shared query that includes work items from multiple projects.

The calculation can be done by Story Points, Original Estimate, Work Item Count or by any numerical custom field, relying on historical data for each work item within the specified query.

The series to be displayed are configurable, thus allowing you to use the widget as burndown, burnup or both, providing a flexible tool to monitor the agile progress of your project release.

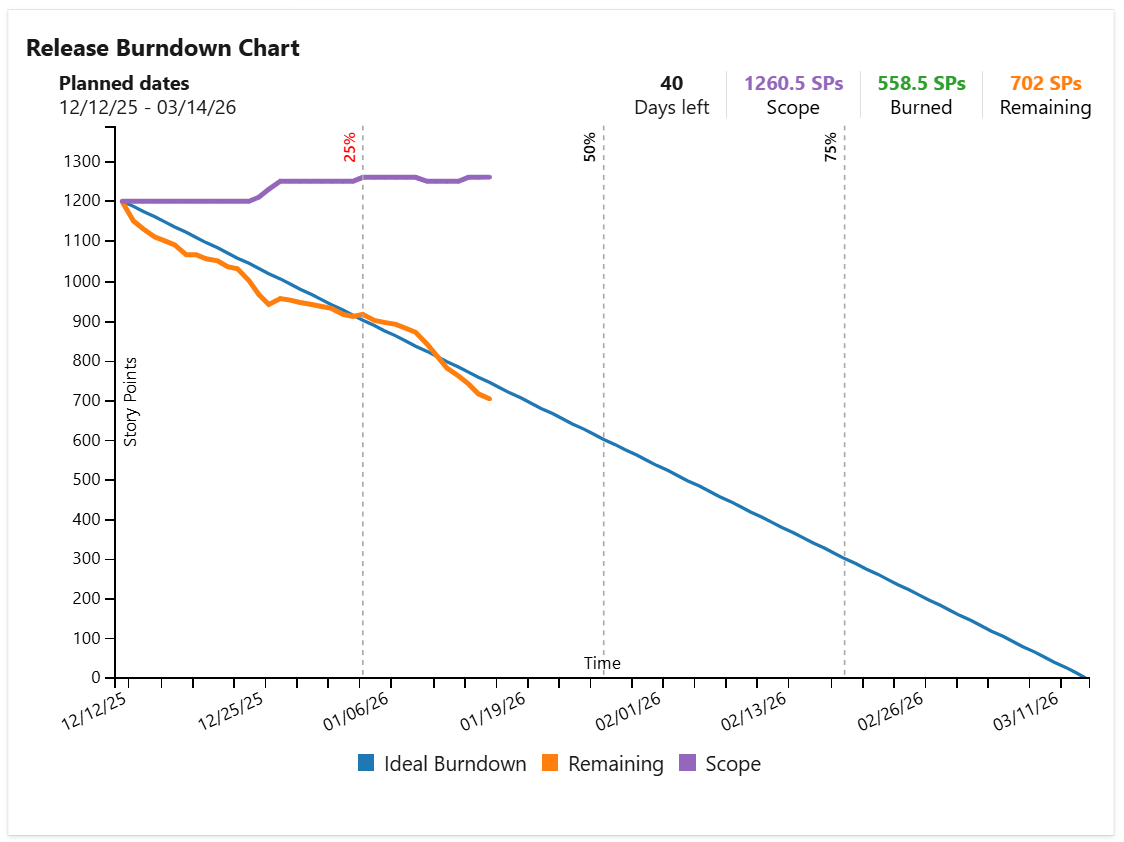

Release Burndown Chart in Azure DevOps dashboards.png

Release Burnup Chart in Azure DevOps dashboards.png

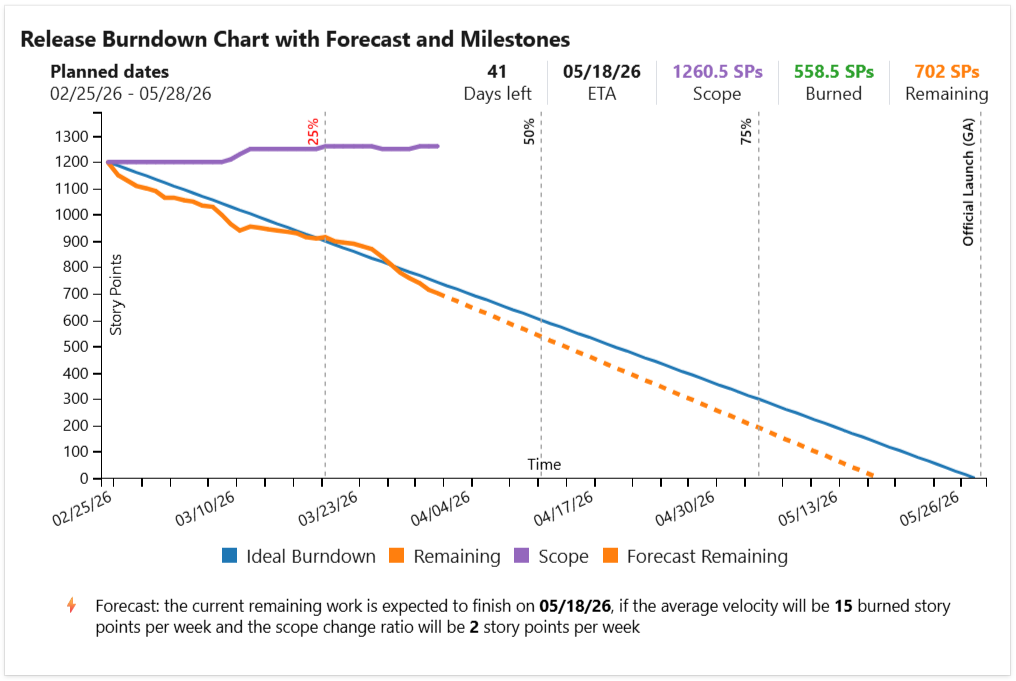

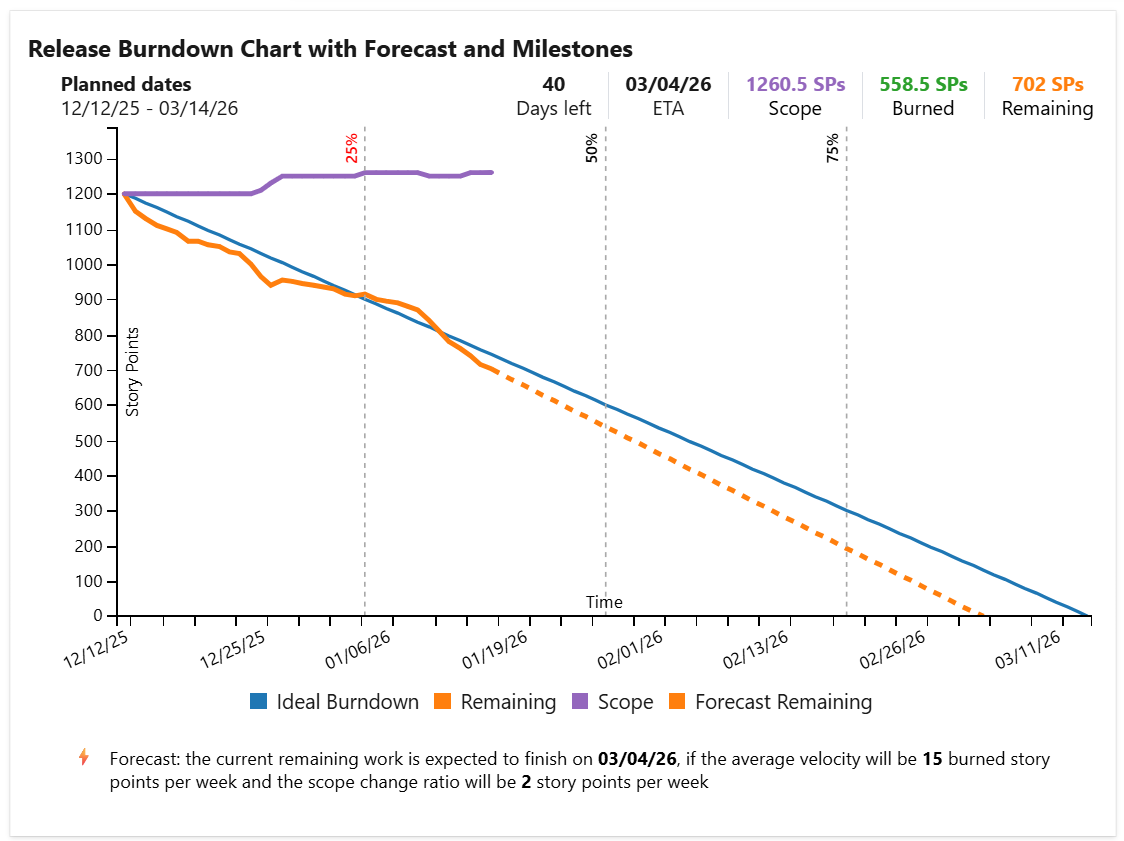

This widget can also make a forecast (prediction) about when the release will be finished.

How is the forecast made? First, it determines the current velocity of your team based on the work done in the previous completed time intervals (Yesterday’s Weather).

Then, it determines how many days are necessary to finish the current remaining work, assuming that your velocity remains the same, and it draws the dashed line accordingly to the determined release end date.

Optionally, you can display release milestones, either as custom dates or as percentages of the planned release timeframe. A past milestone will be displayed in red color if the Remaining work at that time was higher than Ideal Burndown, or in green color if it was lower, making it easy to see whether milestones were reached or missed.

Configuration

The settings of this widget are divided in multiple tabs:

  • Data tab - contains the required settings of the widget, such as title or data source

  • Series tab - lets you choose what series (lines) to display in the chart

  • Forecast tab - contains settings for calculating the forecast lines

  • Milestones tab - lets you choose how to display milestones in the chart

  • More Settings tab - contains various optional settings

  • Colors tab - lets you customize the color of the lines displayed in the chart

Data tab

On this tab you can configure the required settings of the widget.

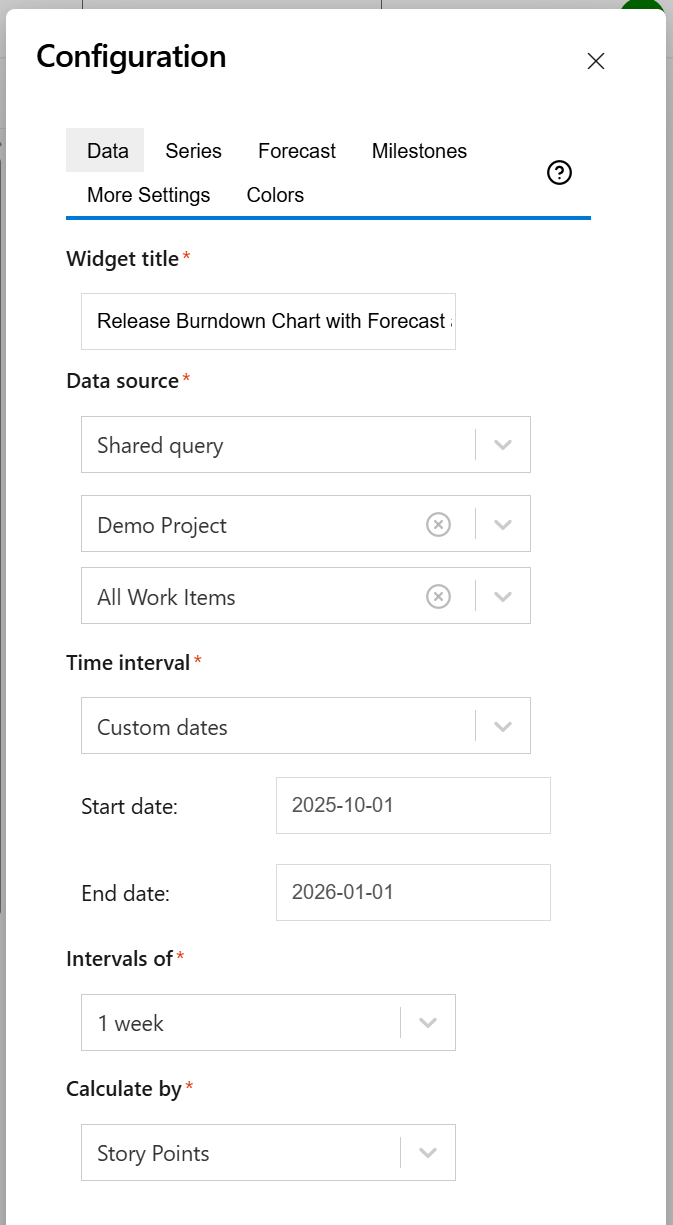

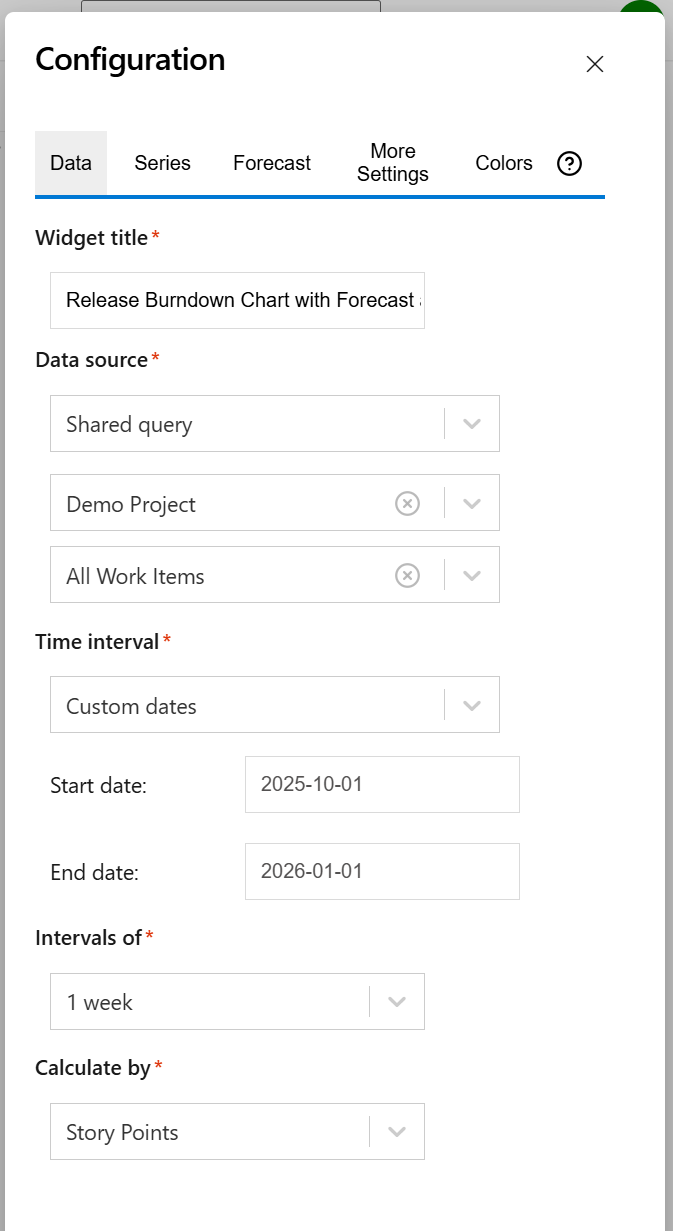

Release Burndown configuration - data tab.png

Setting

Description

Widget title

Choose what to display in the title bar of the widget.

Data source

Select the type of Data source used by the widget:

  • A Shared query that contains the work items in your release (the scope of your project release). Make sure that the specified query is saved in the Shared Queries folder if you want other people to visualize the dashboard and the widget’s results.

You can configure this gadget as cross-project or cross-team burndown / burnup chart by using a shared query that returns work items from multiple projects.

Time interval

Represents the time interval of the release.

You choose from multiple options:

Custom dates - choose this option if you want to manually enter the Start date and End date of the release.

Dates of a sprint - Choose this option if you want the widget to use the start and end dates of an existing sprint. Only the dates are considered (not also the hours). The start of the interval will be the start date of the sprint with time at the start of day, while the end of the interval will be the end date of the sprint with the time at the end of day. When enabled, you’ll need to select the project and team the sprint belongs to. If you choose the Latest sprint (auto), the date range will automatically match the most recent sprint. If you manually select a specific sprint, any changes made to its dates on the board will be automatically reflected in the widget, without the need to reconfigure it.

Be aware that you can also check the Continue to display data after release end date option in the More Settings tab if you want the chart to still display data even if the end date has passed.

Intervals of

Indicates the time interval for calculating the chart data. If you do Agile development, this should be set according to the length of your sprints or iterations.

Calculate by

Specify on which criteria the calculation to be performed. You can choose between:

  • Story Points - the default value; use this option if the work items are estimated in Story Points.

  • Original Estimate - use this if you use time estimates; calculation will be done in hours. The Scope will be calculated as the sum of the Original Estimate field of all the work items from the query, and each time an item is marked as done, the Burned and Remaining lines will increase/decrease with the amount of hours that is set at Original Estimate for that work item. This option does not consider the time spent (Completed Work).

  • Remaining Work & Completed Work - use this option if you use time estimates and your team logs the worked time on a daily basis; calculation will be done in hours. The Scope will be calculated as the sum of the Remaining Work and Completed Work of all the items from the query. Burned is calculated as the sum of Completed Work of all the items from the query plus the sum of Remaining Work of all the items from the query that are done. Remaining is calculated as Scope minus Burned. This option does not consider the Original Estimate field.

  • Work Item Count - use this if you want the calculation to be done by the number (count) of work items.

  • Other numerical custom fields defined in your organization - pickup the numerical custom field that you use to track or estimate the work items.

Series tab

On this tab you can choose what series to display in the chart.

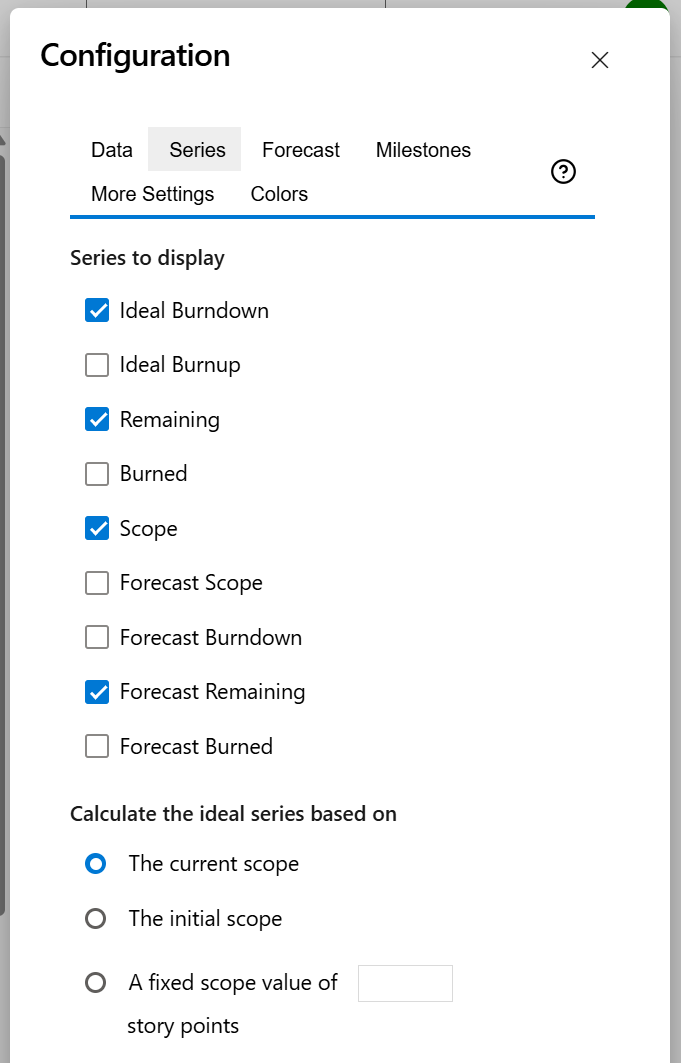

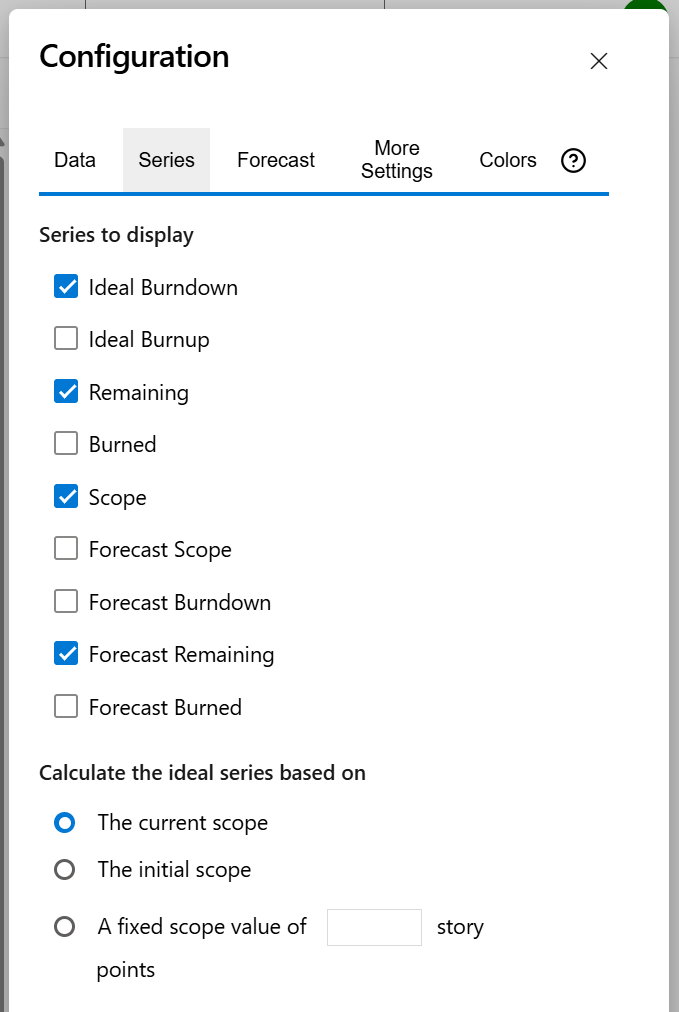

Release Burndown configuration - series tab.png

Setting

Description

Series to Display

Choose what series to display in the chart. You can select one or more options:

Ideal Burndown - the ideal line specific to a burndown chart. It indicates how the remaining work should evolve in the ideal case. It is calculated based on Scope (see below).

Ideal Burnup - the ideal line specific to a burnup chart. It shows how the done (burned) work should evolve in the ideal case. It is calculated based on Scope (see below).

Remaining - the total amount of remaining work at that time; it is specific to the burndown chart.

Burned - the total amount of work done at that time; it is specific to the burnup chart.

Scope - represents the current release goal - the total amount of work to be done in the release at that time. Select this if you want to see the changes in the release scope over time.

Forecast Scope - makes a forecast (prediction) about the scope and displays it as a dashed line between the end of the Scope line and the release end date.

Forecast Burndown - makes a forecast (prediction) about when the remaining work is finished and displays it as a dashed line between the start of the release and the estimated release end date.

Forecast Remaining - makes a forecast (prediction) about when the remaining work is finished and displays it as a dashed line between the end of the Remaining line and the estimated release end date.

Forecast Burned - makes a forecast (prediction) about when the remaining work is finished and displays it as a dashed line between the end of the Burned line and the estimated release end date.

The calculation of forecast lines is based on the settings in the Forecast tab.

Calculate the ideal series based on

Choose how the ideal series will be calculated.

The current scope means that the Ideal Burndown line starts from a value that is the same as the current (latest) value of the Scope series.

The initial scope means that the Ideal Burndown line starts from a value that is the same as the value of the Scope series at the start of the release.

A fix scope value of lets you specify a number representing the total work estimate of the release. This third option is useful when you have a rough estimate of the total work but have not yet added all the corresponding work items or estimates in.

Tips & Tricks

  • To configure the widget as a "classic" burndown chart, select only the Ideal Burndown and Remaining series.

  • To configure the widget as a "classic" burnup chart, select only the Ideal Burnup and Burned series.

  • To configure it as an epic burndown / burnup chart configure the widget to use a query that returns the work items that belong to that epic.

Forecast tab

On this tab you can define how the forecast lines are calculated.

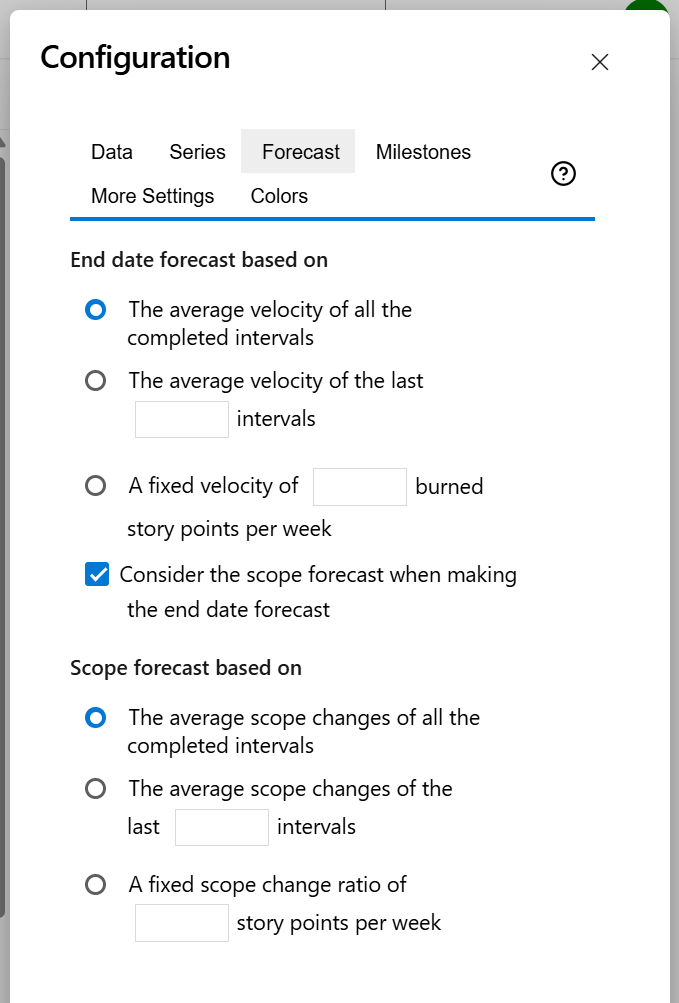

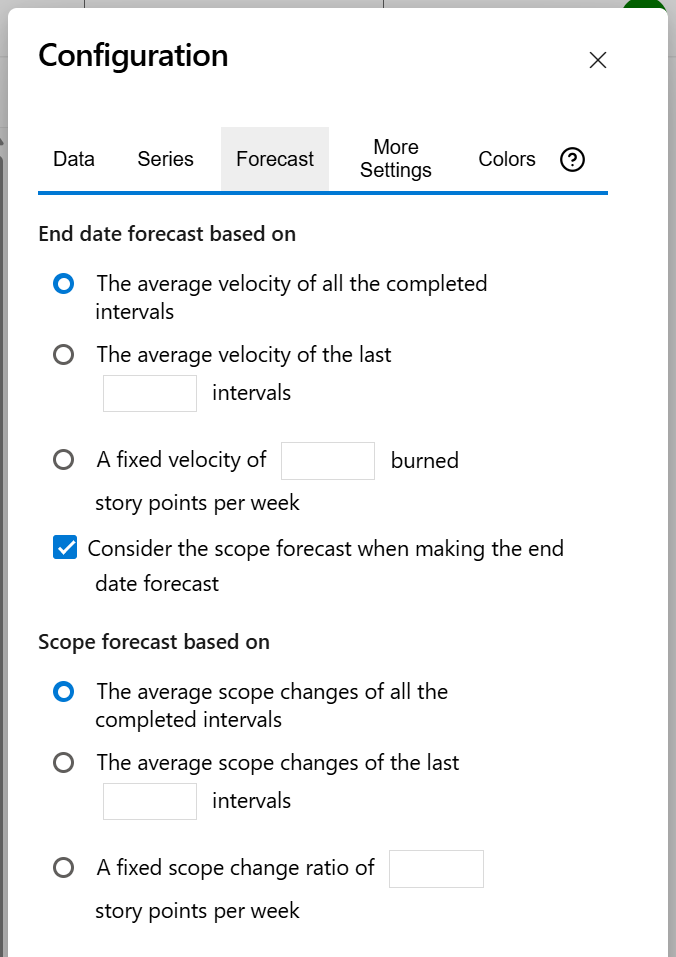

Release Burndown configuration - forecast tab.png

Setting

Description

End date forecast based on

Specify how the end date forecast is calculated.

The average velocity of all the completed intervals - by choosing this option the end date forecast will be calculated based on the average velocity (average amount of work completed) of all the completed time intervals from the chart.

The average velocity of the last x intervals - by choosing this option the scope forecast will be calculated based on the average velocity (average amount of work completed) of the most recent x completed time intervals from the chart.

A fixed velocity of … - by choosing this option the scope forecast will be calculated based on a fixed velocity, entered manually.

These settings affect all the forecast series, except Forecast Scope.

Consider the scope forecast when making the end date forecast

By checking this option, the calculation of the end date forecast will also take into account the scope forecast, not just the velocity.

Scope forecast based on

Specify how the scope forecast is calculated.

The average scope changes of all the completed intervals - by choosing this option the scope forecast will be calculated based on the average scope change ratio of all the completed time intervals from the chart.

The average scope changes of the last x intervals - by choosing this option the scope forecast will be calculated based on the average scope change ratio of the most recent x completed time intervals from the chart.

A fixed scope change ratio of … - by choosing this option the scope forecast will be calculated based on a fixed change scope ratio, entered manually.

These settings affect the Forecast Scope series, as well as the other forecast series if the Consider the scope forecast when making the end date forecast is checked.

Milestones tab

On this tab you can configure how milestones are displayed in the gadget.

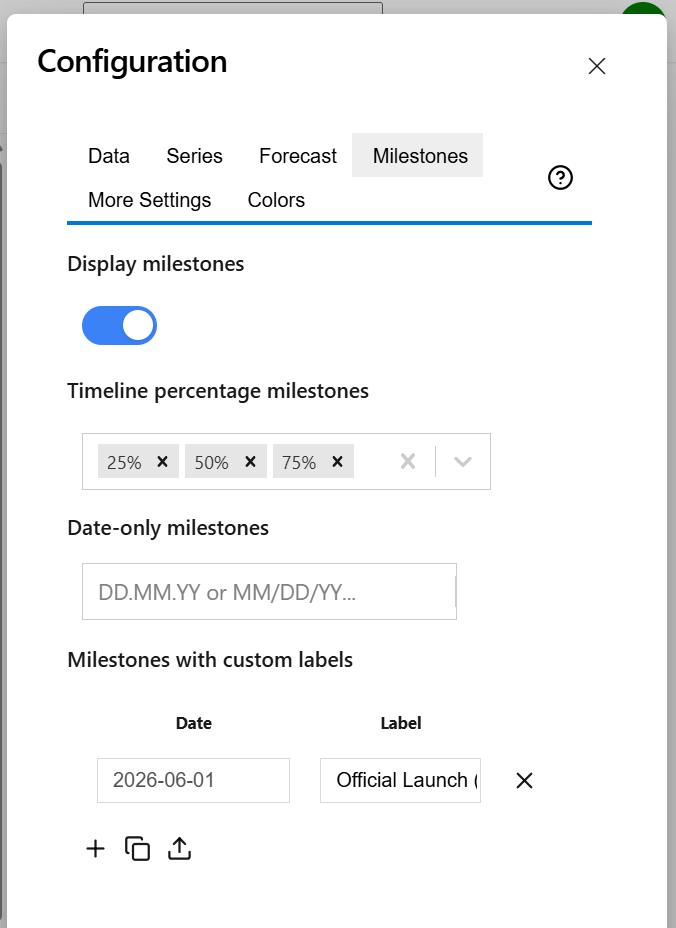

Release Burndown configuration - milestones tab.png

Setting

Description

Display milestones

Enable this option to display your configured milestones in the gadget.

Timeline percentage milestones

Enter the percentages values corresponding to the milestones to be displayed.

Date-only milestones

Enter the dates corresponding to the milestones to be displayed in either DD.MM.YY or MM/DD/YY format.

Milestones with custom labels

Select a milestone’s date and enter a custom label to be displayed in the gadget. You can add a new milestone by clicking the “+” button.

More Settings tab

On this tab you can configure the optional settings of the widget.

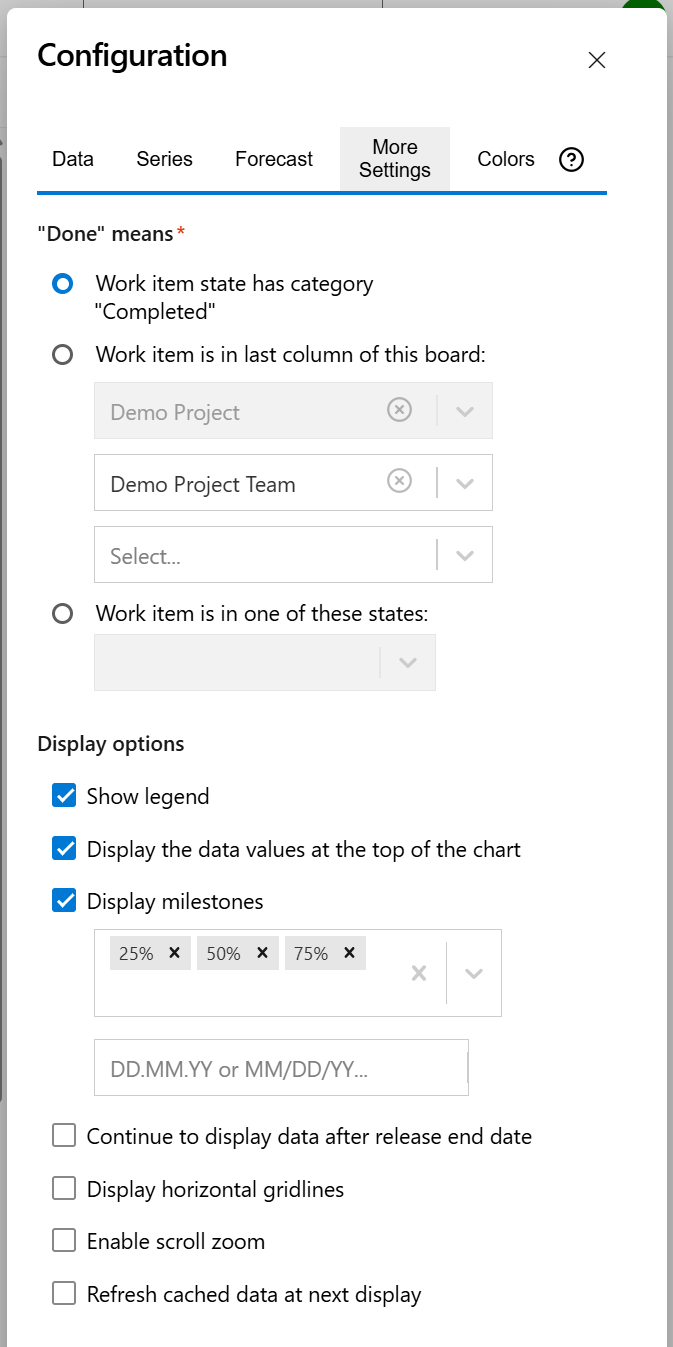

Release Burndown configuration - more settings tab.png

Setting

Description

"Done" means

Specify how the widget should consider work items as done when determining the work completed.

The default option is Work item state has the category “Completed”, which means that the item is considered done if it has reached a state in “Completed” category (such as Resolved, Closed, Done).

Choose Work item is in one of these states, and then select one or more workflow states, to consider work items as done when they reach one of these custom states.

Show legend

Check this if you want the chart legend to be displayed.

Display data values at the top of the chart

Check this option if you want the gadget to display key data values (like planned dates, ETA, days left, burned, remaining, scope) at the top of the chart. When possible, these values include a link that opens a filter containing the work items that produced that value.

Continue to display data after release end date

Check this option if you want the chart to still display data even if the release date has passed. When this option is checked, the chart lines Scope, Remaining, Burned and forecast will continue after the release end date.

Display horizontal gridlines

Check this option if you want the chart to display gridlines for the vertical axis.

Enable scroll zoom

Check this if you want to be able to zoom in while scrolling with the mouse wheel over the chart.

Refresh cached data at next display

This widget uses data caching for faster display, which means that some resulting data after processing is saved and reused the next time the widget is loaded. If you check it, the cache of the widget will be cleared and recreated on the next reload. This setting is not persistent.

Colors tab

On this tab you can customize the color of the lines displayed in the chart.

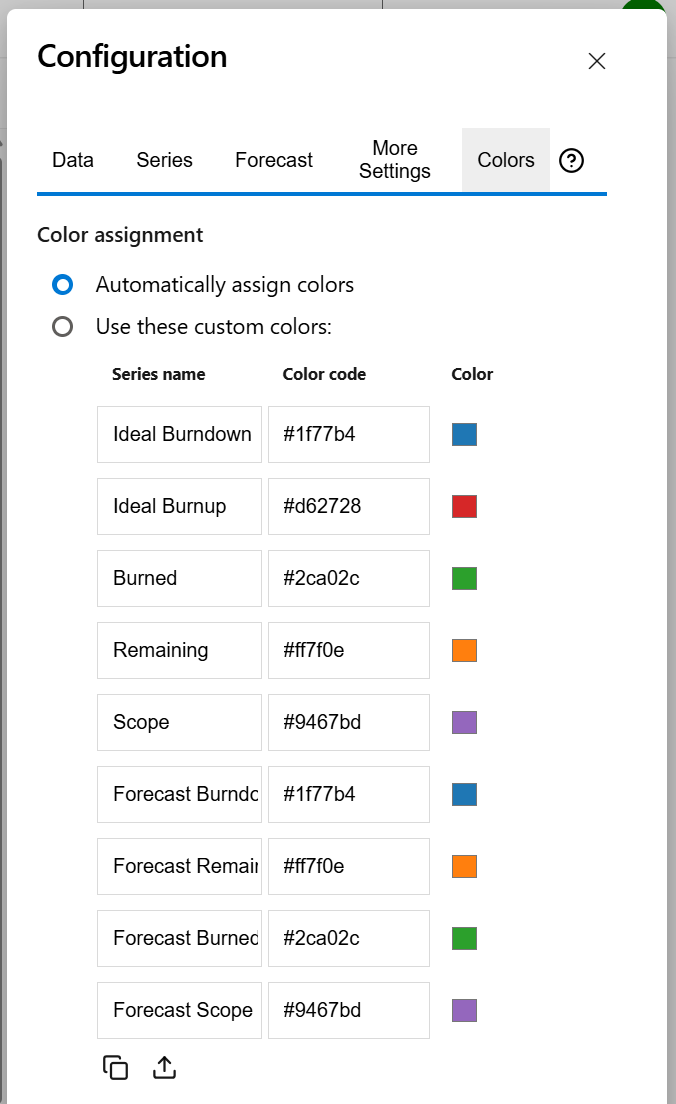

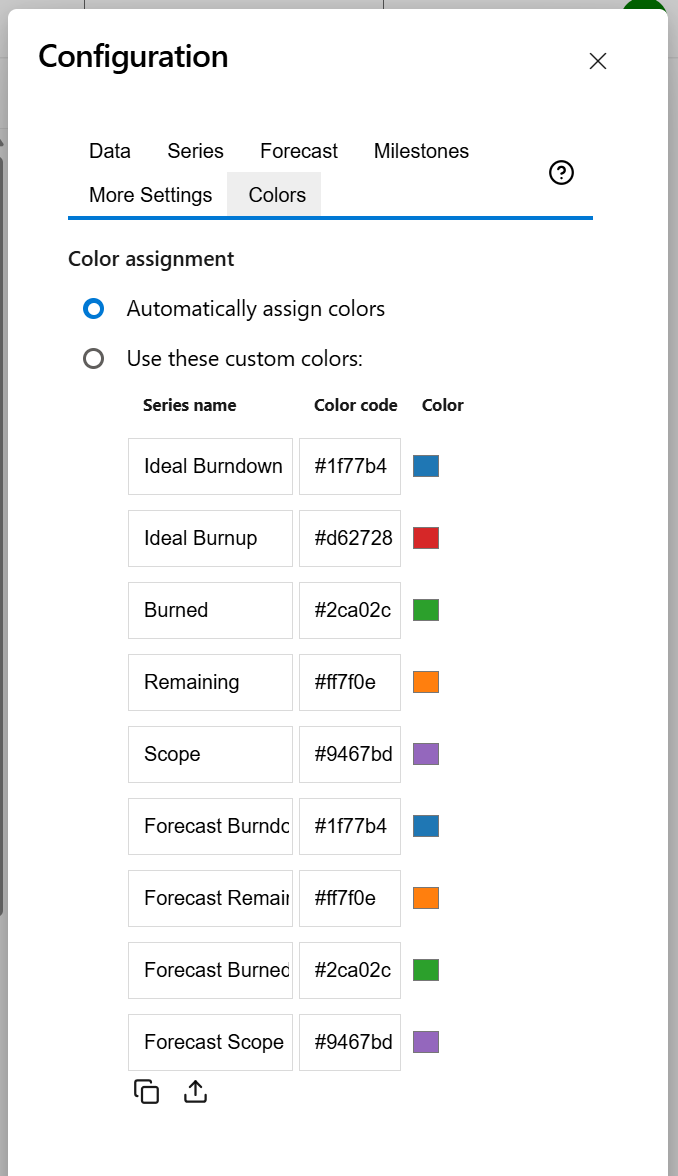

Release Burndown configuration - colors tab.png

Setting

Description

Automatically assign colors

Check this if you want the chart to automatically assign colors for the series.

Custom colors

Select any custom color you want the series to be displayed on by either entering the color's hexadecimal code or picking a color.

You can also use the Copy and Import buttons to copy and import the color configuration to widgets of the same type.
